Tompkins Center for History and Culture Renovation Update, 12/2018

28 12 2018

The new Tompkins Center for History and Culture is progressing towards its April 2019 opening. There’s not much to see from t he outside, since this is an interior renovation, albeit a major, to-the-studs renovation. Some non-load bearing walls have been removed and the interior has been opened up. Back in October, the History Center spearheaded a community effort, called “Moving History Forward”, to move its thousands of historical artifacts from their old location in Gateway Center to the new TCHC a couple blocks away. Not only did it engage the community (the move required 330 volunteers), it also saved about $40,000 in moving expenses.

According to the building permit from October, LeChase Construction is on board as the general contractor for the $1.8 million project. Although based out of Rochester, LeChase maintains offices throughout the state – the firm opened an office in Ithaca, but the company website does not suggest it’s full-service, if it’s still used at all. Most Ithaca work is overseen by the Syracuse office. Matco Electric Corporation of Vestal is in charge of electrical work and rewiring, Lansing’s DFM Mechanical is doing the plumbing, and Eagle Mechanical of Wolcott (Wayne County) is doing the general mechanical work. Local firm Hayes Strategy is serving as the construction project manager, and STREAM Collaborative is designing the interior renovation. New York’s Tessellate Studio is designing the new exhibit area within the renovated space, and some of those images are included below. From Tessellate’s website:

“The intent of the exhibits at the History Center in Tompkins County is to connect audiences to meaningful history and narratives about the past, present and future of the region through the use of interactive, immersive, media and object-based experiences. For this project, Tessellate designed a flexible series of modular Story Pods to work as a physical, visual, and technical system to accommodate current and future needs of the museum. This allows for an open floor plan, use of vertical space and height, dynamic header text/images, visitor seating, accommodating for groups, and the blend of physical, interactive and media design offered an optimal storytelling experience.”

Quick aside, Marchuska Brothers Construction was the county’s general contractor, Johnson Controls had the mechanical contract and Richardson Brothers the electrical contract for the initial renovation work. Not sure why there was a switch. The switch was because the History Center hired their own set of contractors for their buildout needs. From the architect, Noah Demarest: “The county owns the building so they had a contract to deal with some core facilities issues. Now the History Center is using their own contractors for the tenant build out. So it wasn’t a change, just the result of the open bidding process of two different entities working in the same space.”

A project description and development timeline can be found here.

City Centre Construction Update, 12/2018

28 12 2018

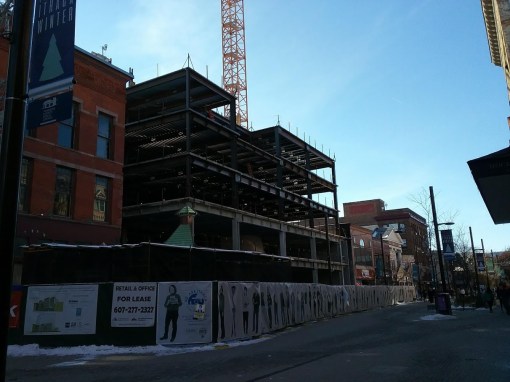

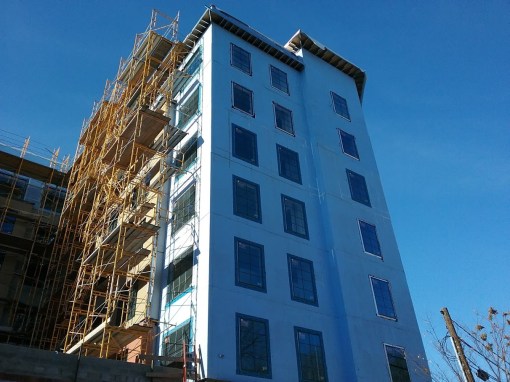

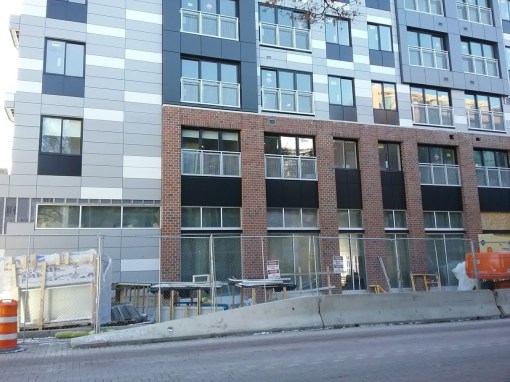

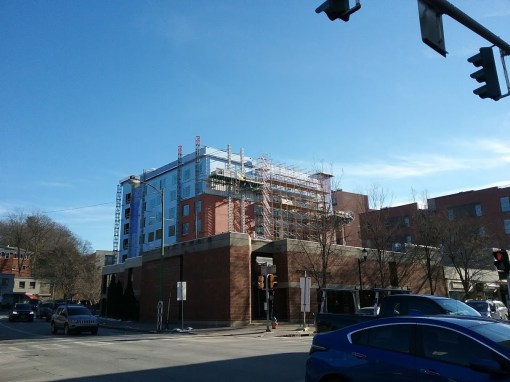

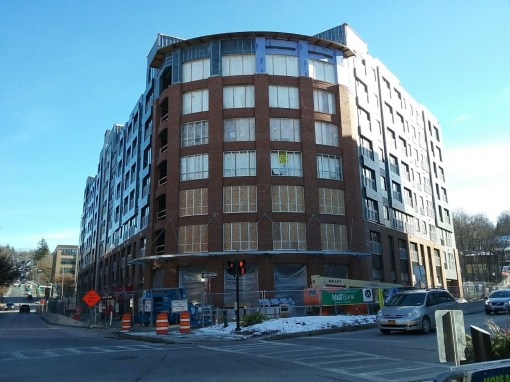

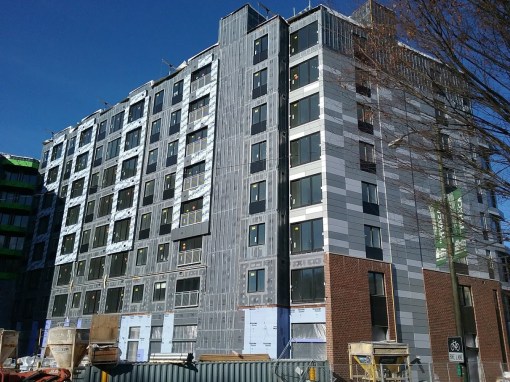

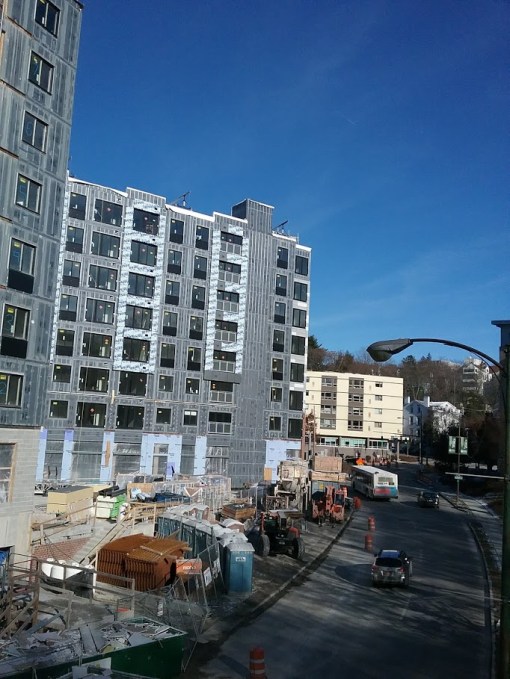

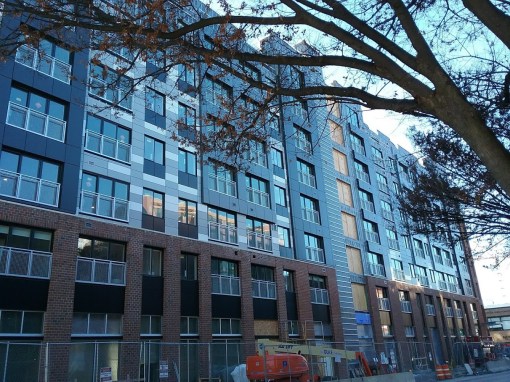

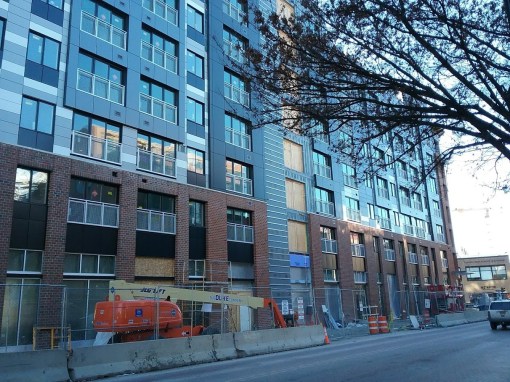

Facade installation continues on the exterior of the City Centre project on the 300 block of East State Street. According to project representatives, all three commercial retail spaces on the ground level have been reserved. Along with the Ale House, the other spaces will be “a financial institution and a new dining experience from a beloved local restaurateur”. The rumor mill has suggested a couple of names for that restaurateur, and that the initial concept was to be Italian, but with the opening of Pasta Vitto across the street, the tenant is taking the restaurant in a new direction.

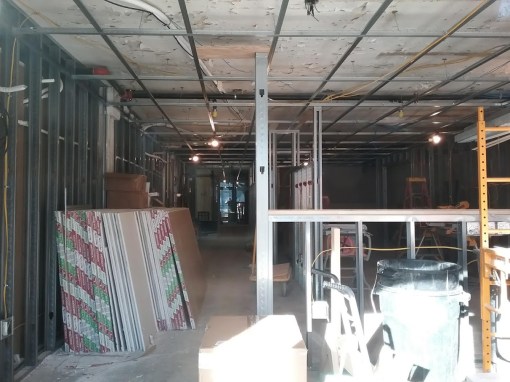

For those interested (and not necessarily looking for a new apartment), City Centre has finished out a few model units for hard hat tours. You can stop by the leasing office on the Commons to schedule a walkthrough.

Some of the project team members have started to tout their involvement with the project, which is generally a good sign (it means they’re proud of their work). The image above comes from Whitham Planning and Design, of which I’m kinda jealous. Meanwhile, the regional Carrier equipment dealer is touting the project’s use of a Toshiba-Carrier VRF HVAC systemVariable Refrigerant Flow, the technical name for the electric heat pumps the building utilizes. The heat pump system and its units are being installed by Petcosky and Sons, a heating and plumbing subcontractor out of Vestal. Purcell Construction is the general contractor (and their City Centre webcam is here).

The project is still on target for a June 2019 opening. The project background and description can be found here.

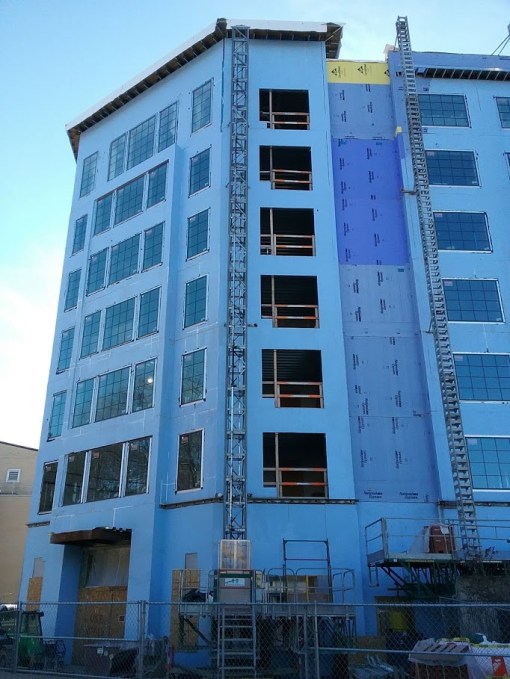

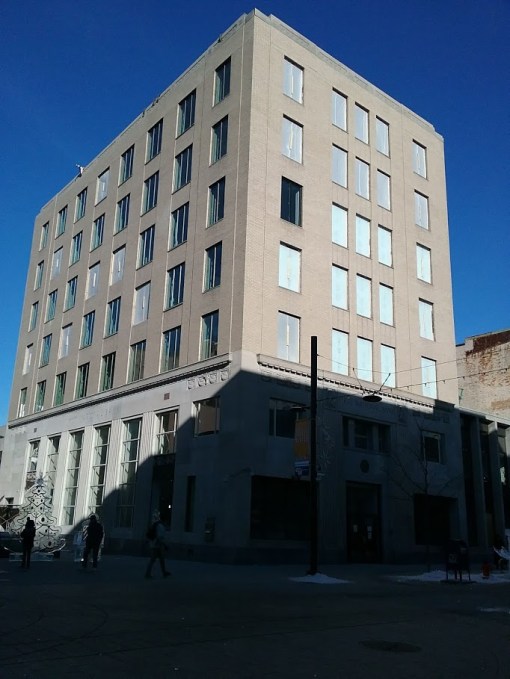

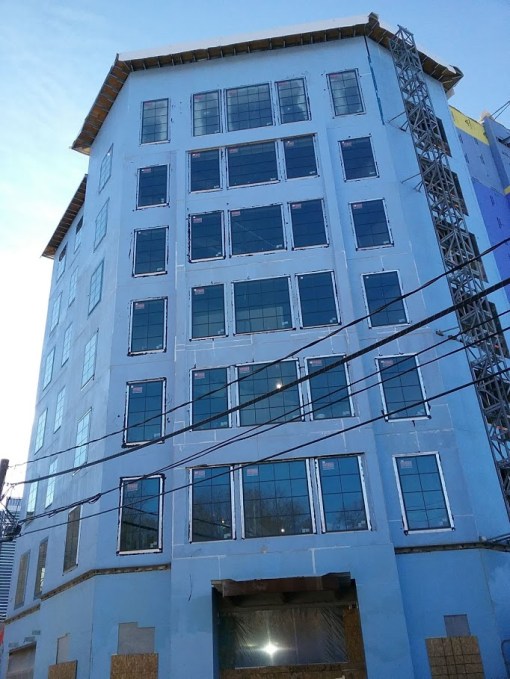

Bank Tower Renovation Update, 12/2018

27 12 2018

Plodding along here; it’s been a year since the project description and introductory post was written. The Fane Organization, which owns the building, is touting January 2019 availability for office suites on Floors 3-7. Floors 1 and 2 are “the new world headquarters for CFCU Credit Union”. Given the windows opening tarped over and awaiting replacement, and the state of the ground level (drywall and rough-ins ongoing, but fixtures and finishes still a ways out), that seems a bit optimistic. I have not heard of any changes to the original plan for CFCU to open at 202-204 East State Street next spring.

The new building logo, courtesy of the Fane Organization.

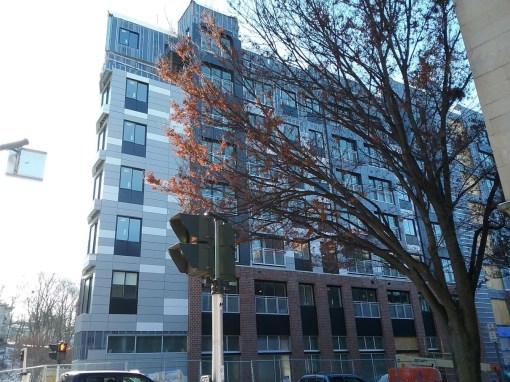

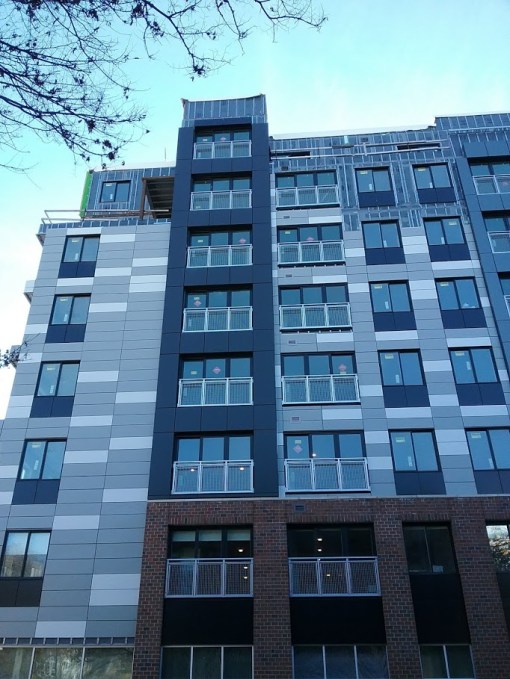

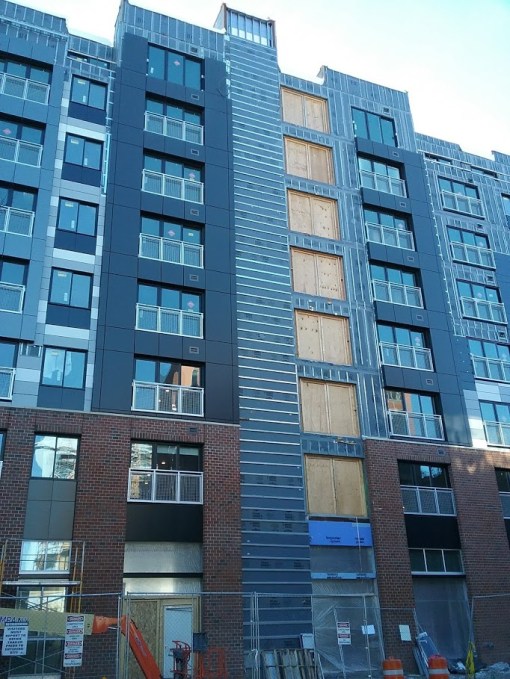

Harold’s Square Construction Update, 12/2018

27 12 2018

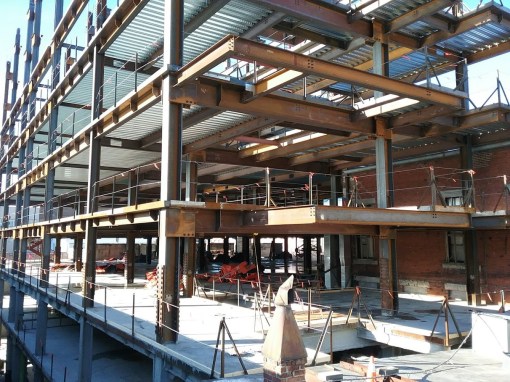

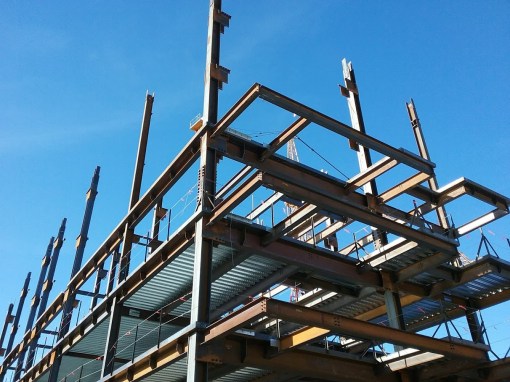

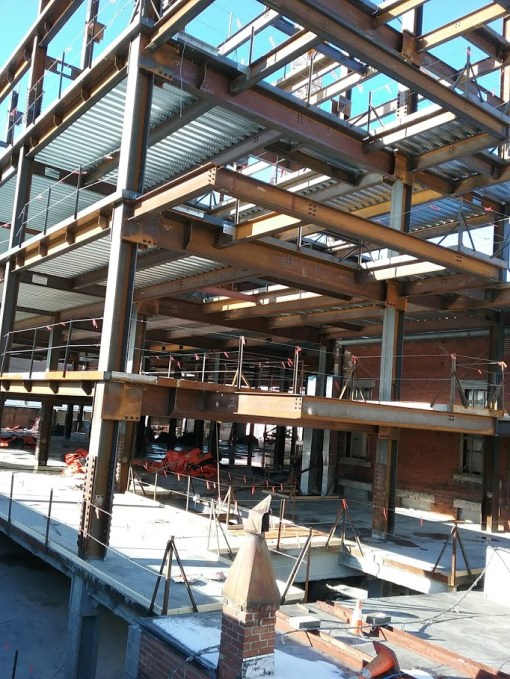

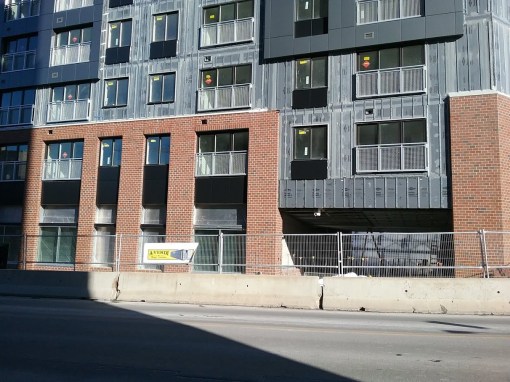

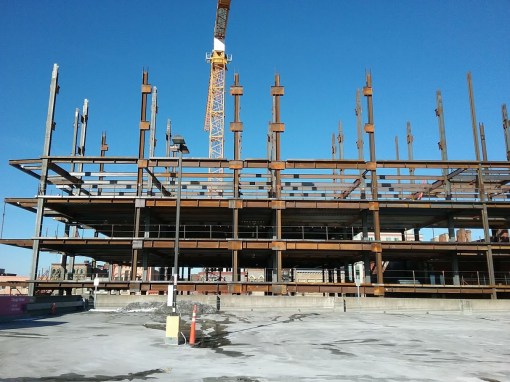

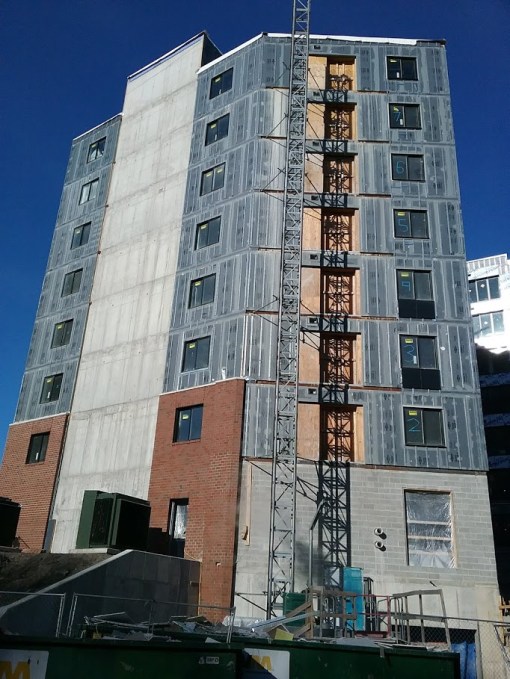

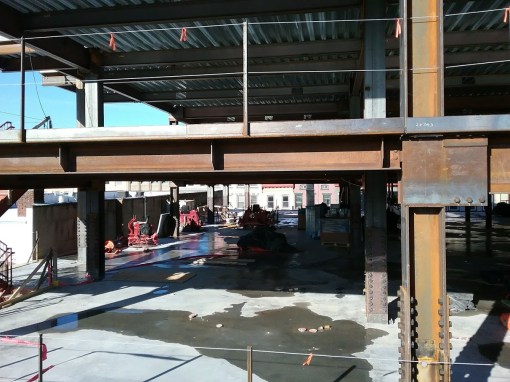

Just noting that the structural steel frame is fully built out up to the fifth floor and that fireproofing and sprinkler system installation is underway. The project utilizes SidePlate Systems for lateral steel connections, which utilizes a lighter frame design that is still durable. This has a higher upfront cost in design, but may balance out much of that with reduced materials and labor costs, as well as being able to stick to a tight buildout schedule. The IBEW (International Brotherhood of Electrical Workers) Local 241 is proudly touting their involvement with the buildout, and local labor advocates will be pleased by the commitment to local union labor. Taylor the Builders is the general contractor.

The apartment units have begun showing up online, though they are not able to be reserved just yet and no prices are given. The units come in the following sizes:

Studio 1 Bath 42 units 435 SF
1 Bed 1 Bath 32 units 686 SF
2 Beds 2 Baths 34 units 945 SF

Retail and office spaces are available for lease through Pyramid Brokerage’s David Huckle. The first floor Commons-facing units are being offered at $24/square foot (3-5 year lease), and the second and third floor office space is being offered for $22.50-$24/square foot. The retail spaces are 2,674 SF, 2,900 SF and 9,210 SF, which can be combined by a deep-pocketed lessee for a maximum of 16,241 SF. The minimum leaseble office space is 2,900 SF (which Pyramid describes as being about enough for seven people in a Class A environment), and the maximum is 33,832 SF (enough for 135 workers). The online as says a 2022 completion, which is overly, overly conservative. I would take a guess at Q4 2019 or Q1 2020. Obviously not the Spring 2019 they originally hoped for, but there have been numerous weather issues that delayed the concrete pours for weeks. The rest of the steel frame should rise faster since the tower portion (floors 6-12) is only a fraction of the building’s overall footprint.

Cornell Fine Arts Library (Rand Hall) Construction Update, 12/2018

22 12 2018

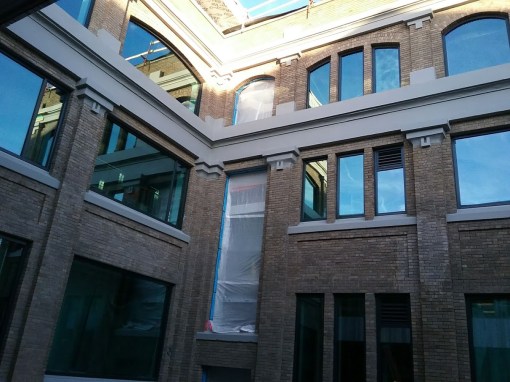

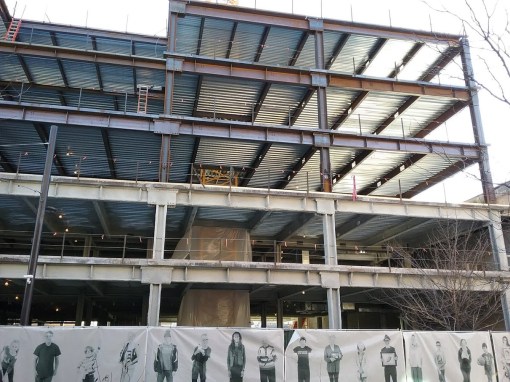

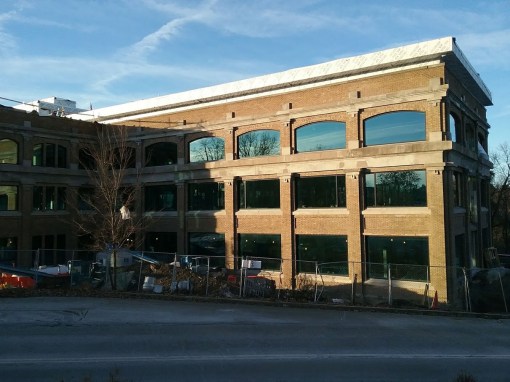

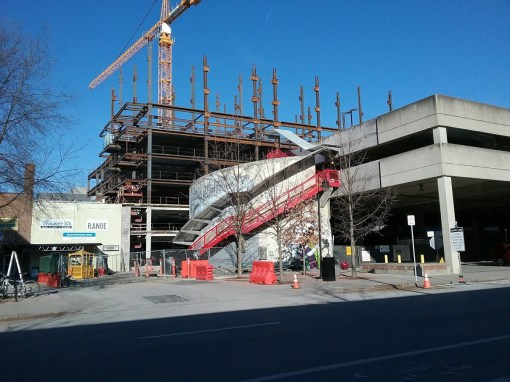

Cornell’s new Fine Arts Library (FAL) is coming along. The Mui Ho Fine Arts Library will occupy the top floors of Rand Hall, a ca. 1911 structure that long housed the design studios of the Department of Architecture. My own memories of Rand were relegated to the outside, usually a small throng of architecture students getting their nicotine fix just beyond the entrance (and on a few occasions, substances more illicit).

Rand has always been the workhorse of the Architecture School and a fine example of early 20th century industrial architecture, but for the past twenty years Cornell actively made one attempt or another to get rid of it – in their attempts to build Milstein, the university proposed to tear down Rand not once, but twice. However, there was significant pushback by alumni and historic preservation groups against the idea, and it was one of the factors that weighed into the Koolhaas design for Milstein Hall, which functions as more an addition to the AAP School than a replacement.

The interior will consist of three levels of mezzanine shelving for the 125,000-volume Fine Arts Library’s collection, as well as interspersed work/study spaces. The library stacks will consist of “inverted ziggurats” accessed by stairs and walkways. Floor-to-ceiling space will range from 48 feet on the north side of the reading room to 7.5 feet in some sections of the library stacks. Long, unobstructed hallways will run the length of Rand Hall. The large variation is meant to convey both grand spaces and “private engagement” with the books. 8,000 square feet of shop space for the AAP program will occupy the first floor. Other features will include reading carrels with built-in monitors and lockable book storage, public computing stations and a seminar room. The roof will host a 1,500 square-foot structural deck, outfitted with base plates for temporary structures as well as power, water and digital connections. The semi-elliptical roof pavilion will be built at a later date.

In this renovation and expansion, Rand’s daylight-factory windows were replaces with single panes, the east stairwell was removed, and a steel canopy is going up over the roof. The building will have two entrances, one public and one for AAP only. In an attempt to limit energy use, the building utilizes rigid foam insulation, installing double-glazed windows and all mechanical systems are being replaced. Like Cornell’s other Central Campus building, Rand/FAL is tied into the Combined Heat and Power system, which uses a mix of renewable and conventional fuel (mostly natural gas) sources.

As previously covered, the architect is a Cornell alum, Vienna-based Wolfgang Tschapeller M.A. ’87. More of Tschapeller’s very avant-garde designs can be found at his website here. The project is being funded in part by a  $6 million dollar donation from Cornell alumna, architect and UC-Berkeley professor Mui Ho ’62 B. Arch ’66.

The $21.6 million project is expected to be completed in June 2019, after a construction period of 18 months. Welliver is the general contractor.

Now at about the two-thirds mark, most of the new windows are in, with clips still in place for the newly installed windows on the east facade. The area of “damage” was the result of the teardown of the eastern stairwell, which was a much more recent construction and not original to the structure. The Carisle VP 705 on the roof is a self-adhering waterproof and fireproof fabric to limit moisture penetration from the aluminum panels.

Press Bay Court Construction Update, 12/2018

21 12 2018

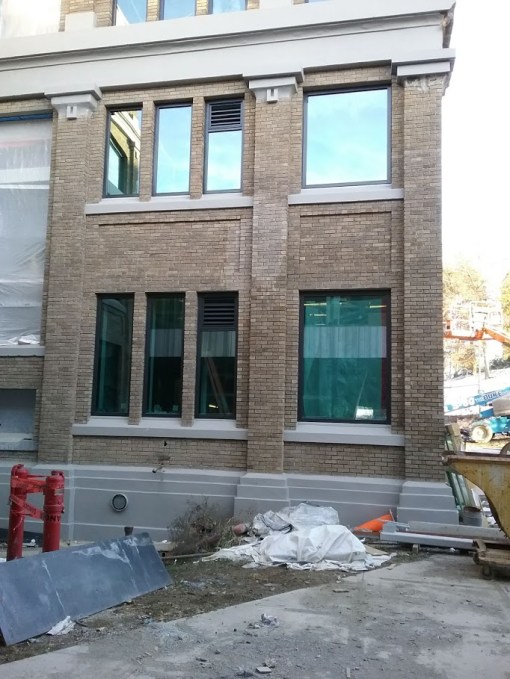

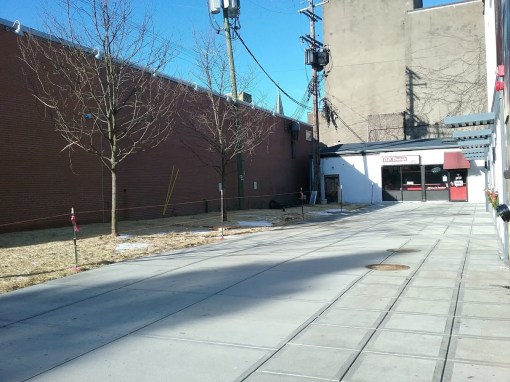

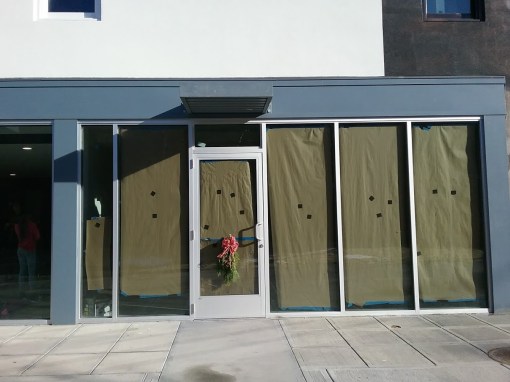

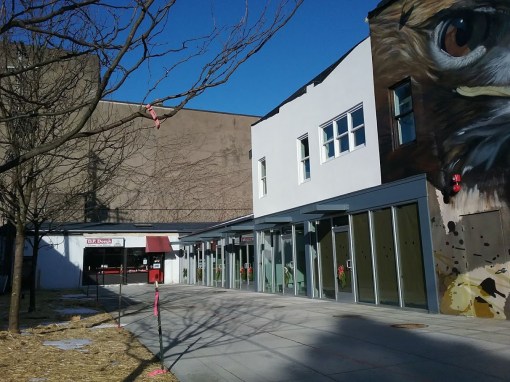

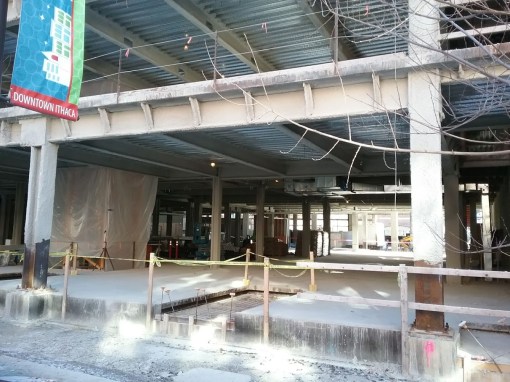

For practical purposes, I’m calling this one complete as of the end of this year. At least one of the new stores was set up and ready for opening (Gee June Bridal) while a couple others were just starting to fit out their spaces with equipment for their own launches. Among them will be Halal Meat and Groceries, One Ring Donuts, Hair • Color • Art and Bramble, an herbal retailer, moving from its Press Bay Alley slot. Calzone restaurant D.P. Dough will move from the rear storefront to the front of the 108-114 West Green retail strip, right along West Green Street in the former Hausner’s Garage. The hawk mural was given a touch up courtesy of Connecticut-based street artist Ryan ‘ARCY’ Christenson.

The fitting out of the West Green Street retail units is ongoing, but the four apartment units are nearly complete with only minor finishing details left, and based off Press Bay Alley’s Instagram, it’s quite the transformation. From their facebook page:

Beautiful historic spaces with modern amenities. These apartments are truly unique. Original 1914 wood rafters and exposed wood deck ceilings, steel beams, and brick surfaces paired with completely new utilities and modern design features

• super-efficient air source heat pumps (heat and AC)
• all LED lighting
• brand new appliances (including dish washer and garbage disposal)
• tasteful modern cabinets with soft close hardware
• beautiful tile bathrooms with modern frameless glass shower enclosures
• freshly refinished original distressed hardwood floors
• Air tight spray foam insulation and high-performance rigid foam on the roof
• Sprinkler system for fire safety

Prices range from $1200-1300/month plus electric*

Included in the rent:

• WiFi Internet**
• Garbage and recycling disposal
• Water service

Apartments are substantially complete and available for a January 1 occupancy

*heat/AC and cooking are all electric, this is a fossil fuel free building

**building is NOT equipped with cable, internet is provided by high speed fiber optic line

$1200-$1300/month is more than the 75% AMI below-market units they were originally aiming for, but not by much – $1200/month works out to $48k-$52k/year, or 80-90% of the local AMI of $59k. “Workforce housing”, to borrow a Visum Development Group term for the 80-90% bracket.

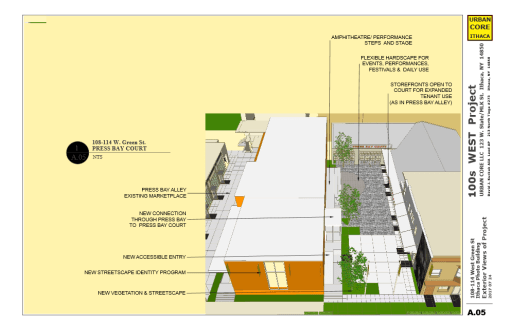

The biggest deviation from the plans appears to be that the passage into the former Ithaca Journal press building has not been built, and instead of vegetation and hardscaping for the amphitheater and court pavers, it’s only vegetation. It’s not clear if the amphitheater and west entry to the press building will be built at a later time.

All in all, this is a great project to have in Ithaca’s Downtown. It extends the vitality of the Commons westward in a form sympathetic to the neighborhood and physical surroundings, making use of a vacant building. It also enhances Press Bay Alley by generating more foot traffic next door. It will provide complementary attractions to make downtown a more engaging place for visitors, and supplies a bit of new moderate-income housing. A big win for the city of gorges.

More info on the development of the project can be found here.

//www.instagram.com/embed.js

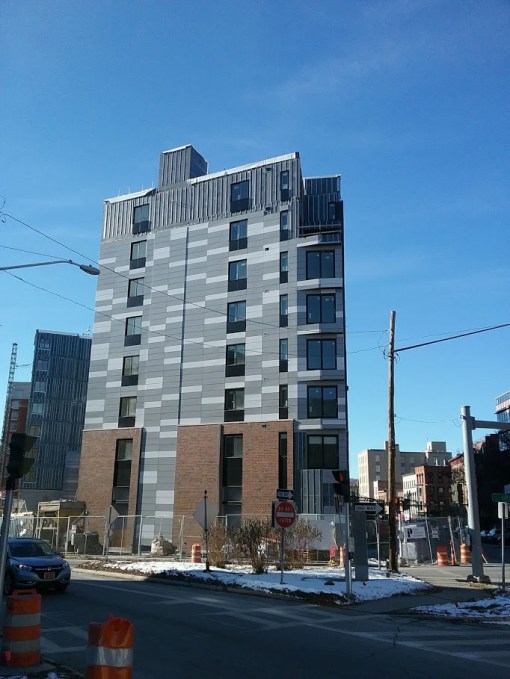

Hilton Canopy Hotel Construction Update, 12/2018

20 12 2018

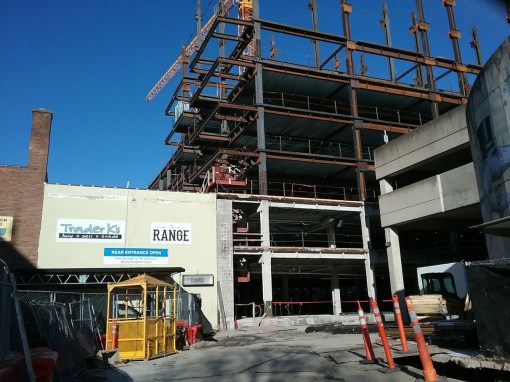

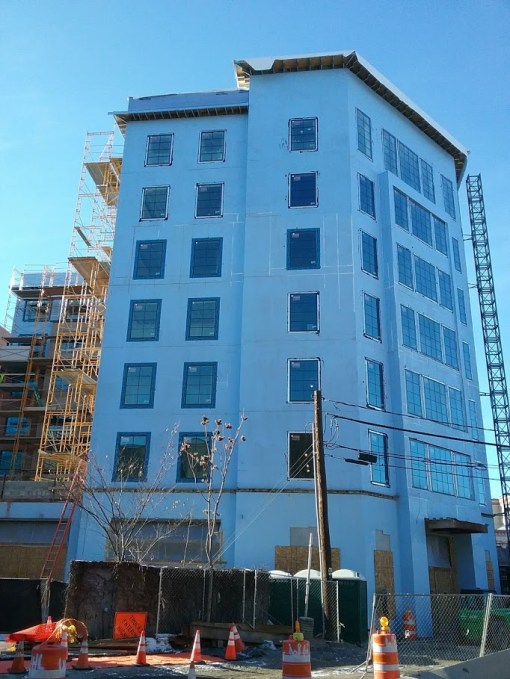

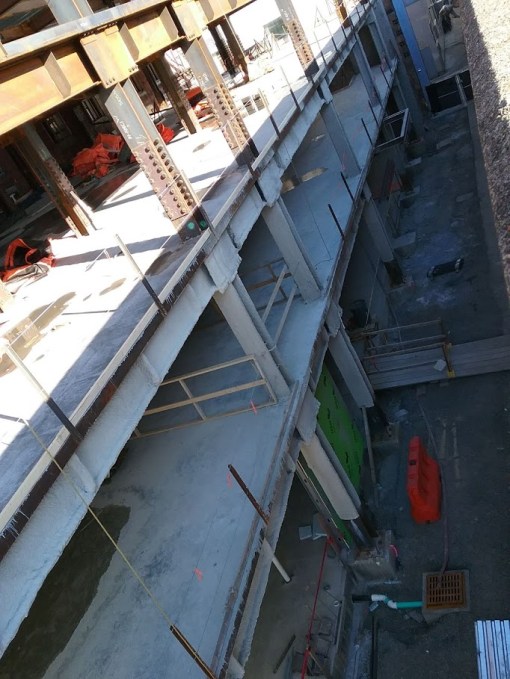

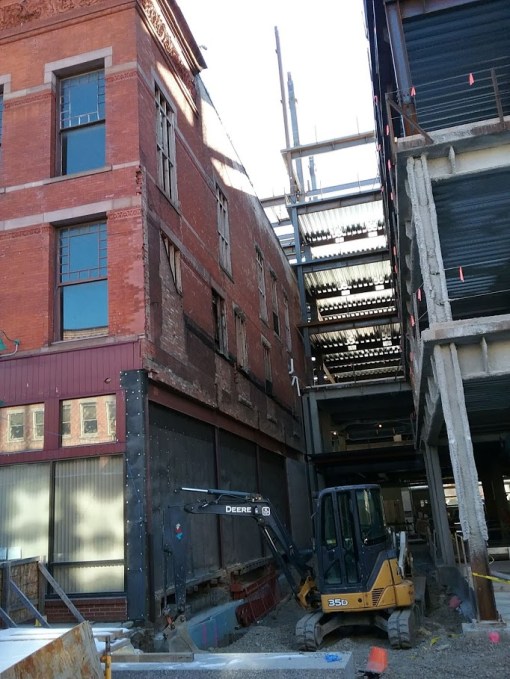

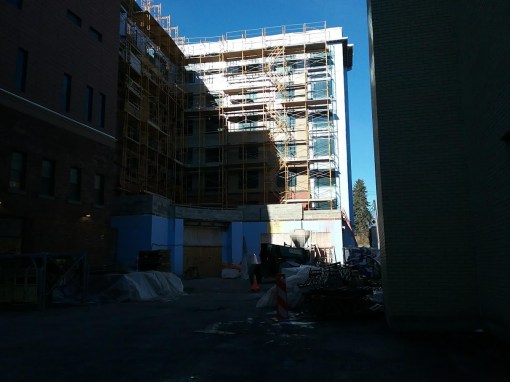

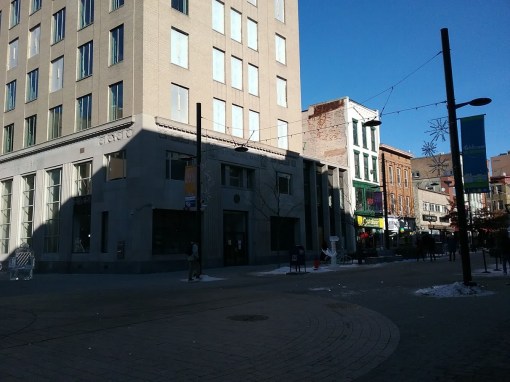

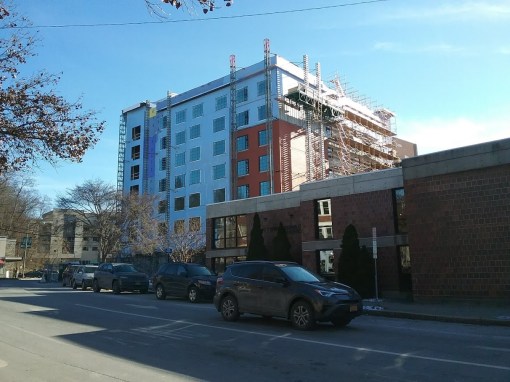

We’re starting to see some of the face materials being attached to the Canopy Hilton’s exterior.The brick veneer is Bowerston Shale Company Red Smooth blend. The bumpout with the industrial-style bay windows will use a darker and browner blend called “Pioneer Smooth”. Some of the “Sauteed Mushroom” fiber cement panels are also visible underneath the scaffolding. “Rockport Grey” and “Dark Ash” (light grey and dark grey) fiber cement panels will be used on the upper levels and to provide visual interest being the bricked spaces. Most of the sheathing is in place, as are most of the windows.The bridge blue bands around some of the windows is probably sealant/waterproofing material.

An interesting little detail here – during the excavation, some remnant fragments were found from the former Stand Theater, which occupied the site from 1917 until its demolition in 1993. It was a grand building in its time, designed in an Egyptian Revival theme (which the Carey Building emulated when it was built a few years later) and capable of sitting 1,650 in golden age splendor. But the theater was never well designed for the transition from stage to screen, and after decades of decay, it closed first in 1976, and then reopened for a few years at the end of the 1970s into the 1980s for live shows, but the expense of maintenance proved a burden on shoestring budgets. Although on the tail end of urban renewal, the car was still king in the early 1990s, and a parking lot was deemed a better alternative to a decaying theater whose revitalization attempts had failed. A few of the more decorative pieces that were found will be put on display in an exhibit inside the hotel lobby.

The 131-room hotel, on the east end of Downtown on the 300 Block of East State Street, is expected to open in 2019. Baywood Hotels, the developer, has been quite busy lately, purchasing the five year-old Fairfield Inn at 359 Elmira Road a few weeks ago. Rather curiously, the $5.9 million purchase of the 106-room hotel was $1.1 million below assessment. The sale used a “bargain and sale deed”, which one often sees with foreclosures. Bargain and sale deeds are riskier than standard deeds. It basically means that if the property has an issue or unpaid bill, you’re on the hook, not the seller.

The curious details of that sale makes me think of a never-completed story the Voice was working on involving the Fairfield. Not long after the Voice launched, the then-owners reached out in an email, saying they had constructed and opened the Fairfield, and after being open almost two years, “we can attest that there is no need for hotel rooms since demand is on a downward slide and we are having trouble servicing our debt. We also feel the Ithaca City officials are artificially generating demand hype to attract more hotel developers along with promises of tax abatement.” We had worked out this idea where their story would be part one, and getting the city and business officials to respond would be part two.

I did an interview with the Fairfield owner and manager, but to prove their claim wasn’t just their hotel and that it was a citywide/regional problem, we needed hard data, proprietary information on occupancy rates and things like Revenue Per Available Room (RevPAR). The regional data of all hotels combined did not back up the claim, and with none of the Fairfield’s peer hotels were willing to take part or even support or refute the Fairfield owners’ claims, there was an inability to expand the story beyond the Fairfield’s anecdotal experience, and so it never moved beyond a first draft. It was the first in-depth story I had worked on that failed to pan out.

In retrospect, I suspect the truth was somewhere in the middle. Given that one of the boutique hotels was cancelled, and how much time was needed for the new downtown hotels to obtain financing, there was clearly some concern from lenders about what the market could support. But because those new hotels are opening over a period of a few years, and local economic growth has continued, the worst fears of the hotel “boom” have been avoided.

Further information on the Canopy hotel can be found here.

News Tidbits 12/17/18

18 12 2018

Here’s a look at the agenda for the city of Ithaca Planning and Development Board meeting this month. It’s a week earlier than usual due to the Christmas holiday. Notes and comments in italics below.

1. Agenda Review 6:00
2. Special Order of Business – Presentation of the Greater Southside Plan 6:05
3. Privilege of the Floor 6:20
4. Approval of Minutes: November 27, 2018 6:35

5 Special Permits 6:40

A. Project: Bed & Breakfast Special Permit
Location: 130 Coddington Road
Applicant: Noah Demarest
Actions: Declaration of Lead Agency, Public Hearing, Determination of Environmental Significance, Potential Consideration of Special Permit Approval

Project Description: The applicant is seeking a Special Permit for use of the property as a homeowner occupied Bed and Breakfast. The property was originally issued a Special Permit in 1998 for operation of the five bedroom home as a homeowner occupied Bed and Breakfast; the Special Permit was not renewed in 2003, as required by §325-9c(4)(g)[3], and has therefore expired. During a recent home inspection, it was discovered the property had continued to operate absent a Special Permit, necessitating a new Special Permit application. No physical alterations to the building or the site are proposed. Issuance of a Special Permit is an Unlisted Action under the City of Ithaca Environmental Quality Review Ordinance (“CEQRO”) and the State Environmental Quality Review Act “(“SEQRA”)

This is a simple case of where the previous owner never renewed the five-year permit and didn’t tell the new buyer, who planned to continue using the home as a live-in Bed & Breakfast. No letters of opposition are on file. Approval, with the proper completion of all necessary forms, is likely to be straightforward.

B. Project: Bed & Breakfast Home Special Permit 6:50
Location: 2 Fountain Place
Applicant: Jason K Demarest
Actions: Declaration of Lead Agency, Public Hearing, Determination of Environmental Significance, Potential Consideration of Special Permit Approval
Project Description: The applicant is seeking a Special Permit to operate the existing 4,492 SF nine (9) bedroom residence located at 2 Fountain Place as a Bed and Breakfast Home. The owner is proposing to utilize four (4) of the nine (9) bedrooms as guest bedrooms for a period not to exceed 21 consecutive days, with a fifth bedroom utilized for home-owner occupancy. Guest occupancy will be limited to two persons or one family per guestroom. No exterior modifications are proposed to the existing home to establish the B&B use, and the existing house is compatible with the character of the neighborhood. Existing parking for seven (7) vehicles exists in the turnaround off Willets Place. The applicant does not propose cooking facilities in the guestrooms, and food service is to be limited to guests of the B&B. No other B&B Homes exist within 500 feet of the property. One sign that is five (5) SF maximum in area and not self-illuminated will be installed in compliance with Chapter 272 of the City Code, “Signs.”

Under city zoning code, B&Bs, which are to be owner-occupied, are allowed to four bedrooms to be used for the guests. A zoning code variance to use eight bedrooms as guest occupancy seemed unlikely, but the new owners believe the B&B may still be viable. Local architect Jason K. Demarest (brother of STREAM’s principal architect, Noah Demarest) is known for his historic restorations and historically-inspired design work, so his involvement is auspicious for those who hope that the century-old mansion and former Ithaca College president’s house retains its character.

6 Site Plan Review

A. Project: Chain Works District Redevelopment Plan (FGEIS) 7:00
Location: 620 S. Aurora St.
Applicant: Jamie Gensel for David Lubin of Unchained Properties
Actions: Review FGEIS & Town Comments – No Action
Project Description: The proposed Chain Works District seeks to redevelop and rehabilitate the +/-800,000 sf former Morse Chain/Emerson Power Transmission facility, located on a 95-acre parcel traversing the City and Town of Ithaca’s municipal boundary. The applicant has applied for a Planned Unit Development (PUD) for development of a mixed-use district, which includes residential, commercial, office, and manufacturing. The site’s redevelopment would bridge South Hill and Downtown Ithaca, the Town and the City of Ithaca, by providing multiple intermodal access routes including a highly-desired trail connection. The project will be completed in multiple phases over a period of several years with the initial phases involving the redevelopment of the existing structures. Current redevelopment of this property will focus on retrofitting existing buildings and infrastructure for new uses. Using the existing structures, residential, commercial, studio workspaces, and office development are proposed to be predominantly within the City of Ithaca, while manufacturing will be within both the Town and City of Ithaca. Project materials are available for download from the City website: http://www.cityofithaca.org/DocumentCenter/Index/119

Hey, they’re starting to include documentation links in the agenda descriptions now! Most of the town’s comments are minor modifications and a possible correction on one of the traffic lane analyses. There’s a boatload of paperwork to dig through, so this meeting is just a chance for the planning board to look at the town’s comments, digest some of the supplemental files, and make sure there are no red flags or major concerns within that subset of information.

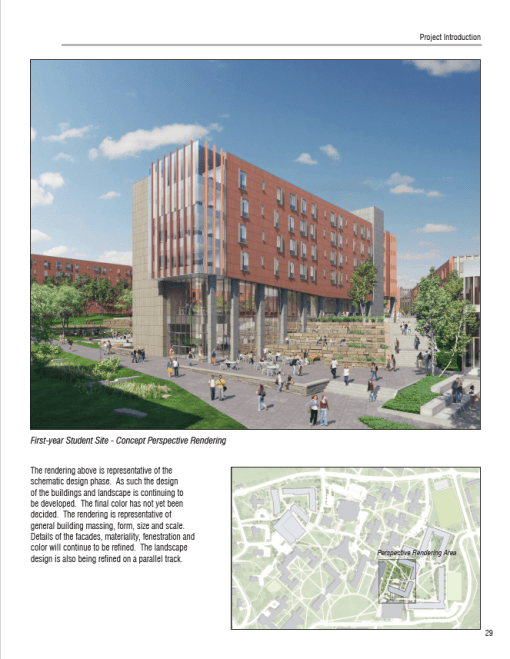

B. Project: North Campus Residential Expansion (NCRE) 7:20
Location: Cornell University Campus
Applicant: Trowbridge Wolf Michaels for Cornell University
Actions: Determination of Environmental Significance
Project Description: The applicant proposes to construct two residential complexes (one for sophomores and the other for freshmen) on two sites on North Campus. The sophomore site will have four residential buildings with 800 new beds and associated program space totaling 299,900 SF and a 59,700 SF, 1,200-seat, dining facility. The sophomore site is mainly in the City of Ithaca with a small portion in the Village of Cayuga Heights; however, all buildings are in the City. The freshman site will have three new residential buildings (each spanning the City and Town line) with a total of 401,200 SF and 1,200 new beds and associated program space – 223,400 of which is in the City, and 177,800 of which is in the Town. The buildings will be between two and six stories using a modern aesthetic. The project is in three zoning districts: the U-I zoning district in the City in which the proposed five stories and 55 feet are allowed; the Low Density Residential District (LDR) in the Town which allows for the proposed two-story residence halls (with a special permit); and the Multiple Housing District within Cayuga Heights in which no buildings are proposed. This has been determined to be a Type I Action under the City of Ithaca Environmental Quality Review Ordinance (“CEQRO”) §176-4 B.(1)(b), (h) 4, (i) and (n) and the State Environmental Quality Review Act (“SEQRA”) § 617.4 (b)(5)(iii). Project materials are available for download from the City website: http://www.cityofithaca.org/DocumentCenter/Index/811

This is likely to be the most contentious part of the meeting. The planning staff have conducted their analysis. Some traffic mitigation measures are sought, including circulation and mass transit / multi-modal transit improvements. The city will make sewer system upgrades a stipulation of project approval, and being next to the Cornell Heights Historic District, the board as Lead Agency wants a more sensitive use of materials and material colors, and extensive vegetative screening to be reviewed further before approval. But the most debated component, the energy use impacts, the city feels is effectively mitigated through the proposed measures by the applicant team.

I’m going to raise one point of correction though – the number of beds is going up to 2,079, but the planning staff should note that a campus-owned fraternity house, the former Sigma Alpha Mu building at 10 Sisson Place (the chapter moved to 122 McGraw Place), is coming down to make way for the project, so the gross number of beds is at least 30 less that that figure.

C. Project: Falls Park Apartments (74 Units) 7:50
Location: 121-125 Lake Street
Applicant: IFR Development LLC
Actions: Review of FEAF Part 3 – No Action
Project Description: The applicant proposes to build a 133,000 GSF, four-story apartment building and associated site improvements on the former Gun Hill Factory site. The 74-unit, age-restricted apartment building will be a mix of one- and two-bedroom units and will include 7,440 SF of amenity space and 85 parking spaces (20 surface spaces and 65 covered spaces under the building). Site improvements include an eight-foot wide public walkway located within the dedicated open space on adjacent City Property (as required per agreements established between the City and the property owner in 2007) and is to be constructed by the project sponsor. The project site is currently in the New York State Brownfield Cleanup Program (BCP). Before site development can occur, the applicant is required to remediate the site based on soil cleanup objectives for restricted residential use. A remedial investigation (RI) was recently completed at the site and was submitted to NYSDEC in August 2018. The project is in the R-3a Zoning District and requires multiple variances. This is a Type I Action under the City of Ithaca Environmental Quality Review Ordinance (“CEQRO”) §176-4 B(1) (h)[2], (k) and (n) and the State Environmental Quality Review Act (“SEQRA”) §617-4 (b) (11). Project materials are available for download from the City website: http://www.cityofithaca.org/DocumentCenter/Index/852

Part III of FEAF is the city planner-written review of impacts, proposed mitigations, and whether the lead agency feels the mitigations are appropriate and effective. Some stormwater, remediation plan and other supplemental materials are still needed before a declaration of significance can be made.

D. Project: New Two-Family Dwellings 8:10
Location: 815-817 N Aurora
Applicant: Stavros Stavropoulos
Actions: Public Hearing
Project Description: The applicant proposes to demolish an existing two-family residential structure and construct two new 1,290 SF two-family dwellings on a 9,590 SF lot. The existing residential building is a legally non-conforming building with a side setback deficiency (2.9 feet instead of the required 5 feet). The proposed redevelopment will include four parking spaces for four three-bedroom apartments. The applicant is requesting the Board’s approval to use the landscaping compliance method for parking arrangement. The project site is located in the R-2b Zoning District and meets all applicable zoning lot and setback requirements. This is an Unlisted Action under the City of Ithaca Environmental Quality Review Ordinance (“CEQRO”) and the State Environmental Quality Review Act (“SEQRA”). Project materials are available for download from the City website: http://www.cityofithaca.org/DocumentCenter/Index/859

City staff were really unhappy about this plan last month, and it was implied that this was one of the examples of “bad” infill that may lead to the new single primary structure overlay. However, barring extreme circumstances (think Maguire at Carpenter Park), review will continue under the current regulations. No new materials appear to have been submitted since the last meeting.

E. Project: Maguire Ford Lincoln Additions and Improvements 8:30
Location: 370 Elmira Road
Applicant: John Snyder Architects PLLC
Actions: Public Hearing, Potential Determination of Environmental Significance

Project Description: The applicant proposes to demolish a portion of the existing building and construct two additions with updated exterior materials. The existing building is 18,500 GSF, with 2,265 GSF proposed for demolition. The new building will be 24,110 GSF. Site improvements include incorporation of a new pedestrian walking path, and site connections to Wegmans. Approximately 311 parking spaces are proposed to accommodate customer, service parking, employee, and display parking. The project site is located in the SW-2 Zone, is subject to the 2000 Southwest Design Guidelines, and will require a zoning variance for a front yard that exceeds the maximum permissible in the SW-2 district (34 feet maximum permitted, 69-feet 3-inch setback proposed). This is an Unlisted Action under the City of Ithaca Environmental Quality Review Ordinance (“CEQRO”) and the State Environmental Quality Review Act (“SEQRA”); however, it will be treated as a Type I Action for the purpose of environmental review. Project materials are available for download from the City website: http://www.cityofithaca.org/DocumentCenter/Index/860

The revised plans include modified architectural features (more windows, a green wall), and a greater amount of vegetated landscaping to comply with zoning. On-site solar panels are being considered per board recommendation, but the old building was not designed to hold the weight of solar panels. The new wings will be designed to host panels. Heat pumps are being evaluated for some functions, but some of the heavy-duty components like the service bay will likely rely on modified conventional fuel systems. The building will meet or exceed NYS Energy Code requirements.

F. West Hill- Tiny Timbers – Sketch Plan 8:50

This one has been a long time coming. Tiny Timbers bought a 5.45 acre parcel on the south end of Campbell Avenue’s 400 block back in September 2016, and has long planned one of its cluster home developments on the vacant lot. As noted at the time on the blog:

“Dolph et al. are looking to do a similar development to the one in Varna on a 5.45 acre parcel at the south end of the 400 Block of Campbell Avenue, which was noted in a weekly news roundup when it hit the market back for $195k in August 2015. The Journal’s Nick Reynolds touched on it in a through write-up he did earlier this week. The comprehensive plan calls this portion of West Hill low-density residential, less than 10 units per acre. Current zoning is R-1a, 10000 SF minimum lot size with mandatory off-street parking, although maybe a cluster subdivision would come into play here. The Varna property is a little over 6 units per acre. If one assumes a similar density to the Varna project, the ballpark is about 35 units, if sticking to the 10000 SF lot size, then 23 units.

On the one hand, expect some grumbling from neighbors who won’t be thrilled with development at the end of their dead-end street. On the other hand, these small houses are modestly-sized and priced, they’ll be owner-occupied, and if the Varna site is any indication, the landscaping and building design will be aesthetically pleasing.”

G. 112-114 Summit Ave – Sketch Plan 9:10

This one required some fact-checking, because 114 Summit Avenue was the former Cascadilla school dorm that came down last year to make way for the Lux apartment project at 232-236 Dryden Road. A better address for this project might be “238 Dryden”, and the rumor mill says it’s by Visum Development Group, who developed the Lux. Although the exact positioning seems uncertain, the parcel north of the Lux is CR-3 (three floors, 40% lot coverage, parking and houselike features such as gables and porches required), and the remaining adjoining parcels are CR-4 (four floors, 50% lot coverage, no parking required). With student housing experiencing a little more slack in the market lately, it’s not clear if this is student housing, or another use.

7. Old/New Business PRC Meeting Time/ Date 9:30

8. Reports
A. Planning Board Chair
B. BPW Liaison
C. Director of Planning & Development 9:40

9. Adjournment 9:50

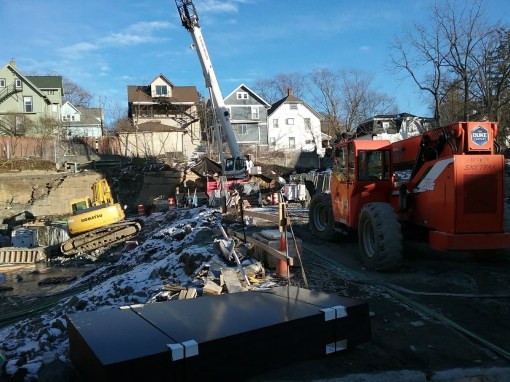

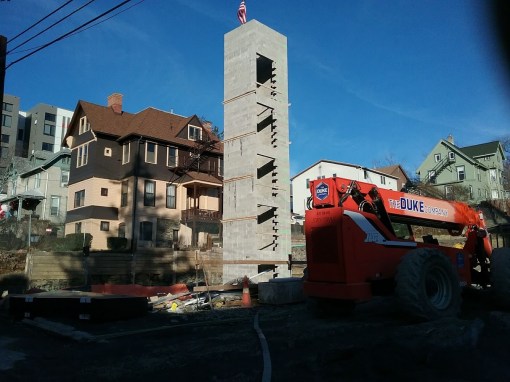

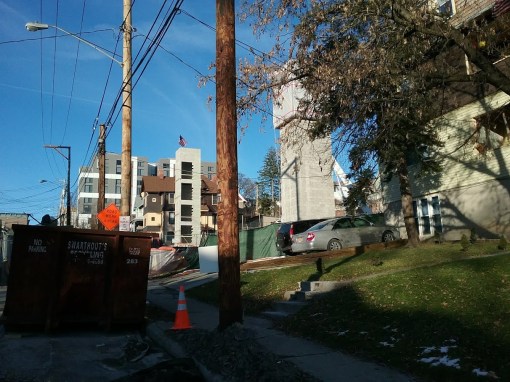

119-125 College Avenue (College Townhouses) Construction Update, 12/2018

16 12 2018

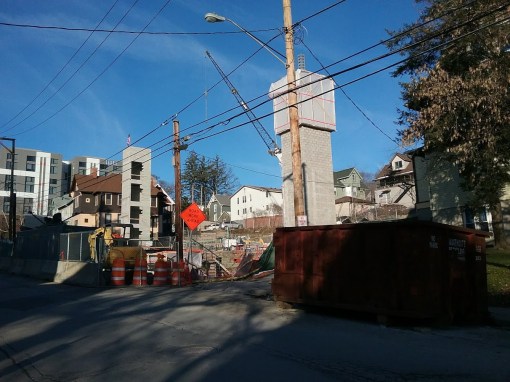

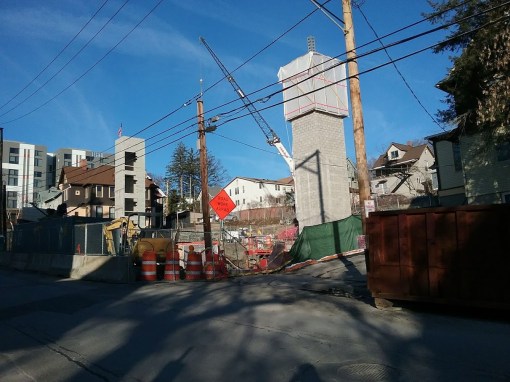

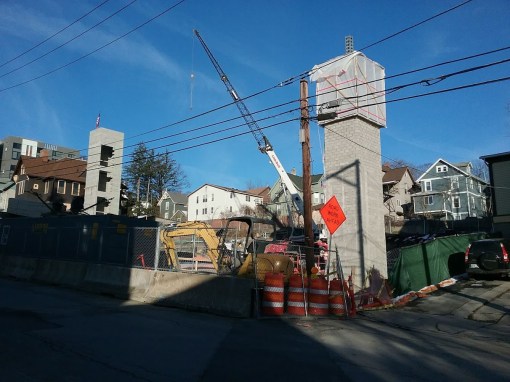

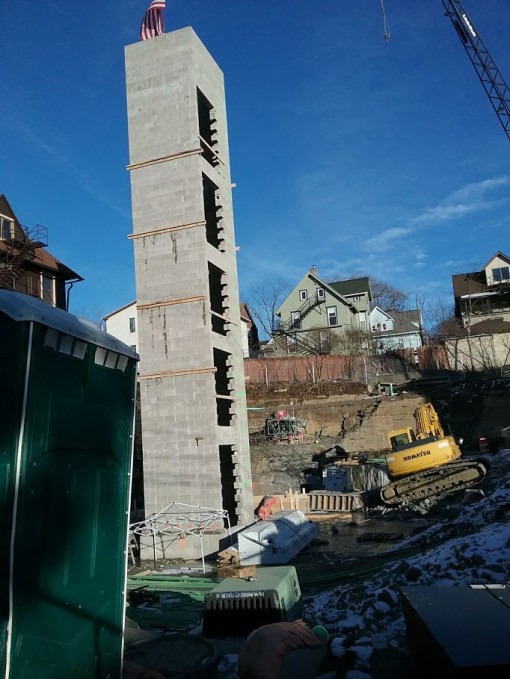

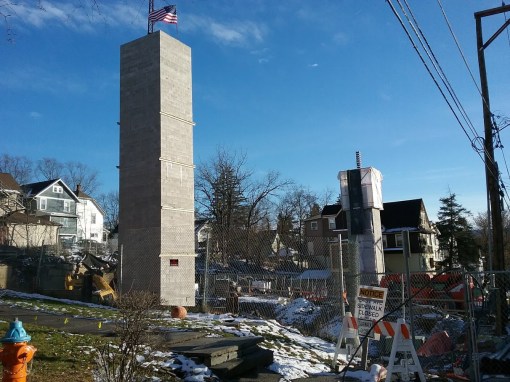

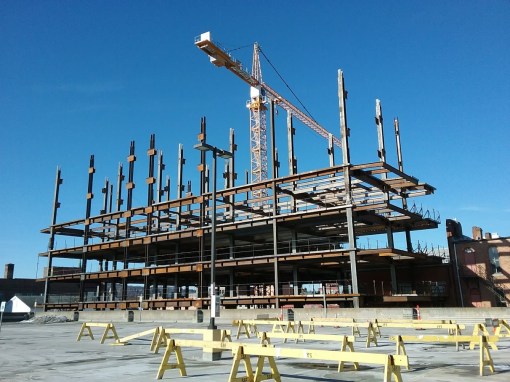

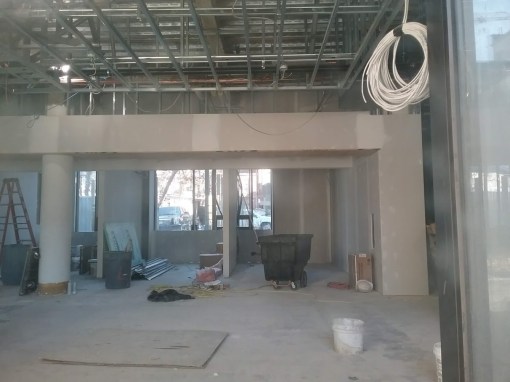

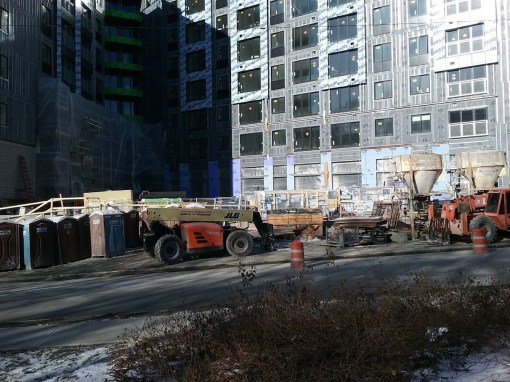

The CMU (concrete masonry unit) elevator/stairwell cores are being assembled for Novarr and Proujansky’s Cornell visiting faculty and staff housing at 119-125 College Avenue. The North Building’s core tower is complete and capped with an American flag courtesy of Welliver (who are proudly displaying their involvement with Cornell’s North Campus Residential Initiative on their homepage, and is co-developed by Novarr and Proujansky). It’s kinda intuitive from the east tower, but workers work their way up along the inside, using the steel girder in the center. The plastic sheeting offers some basic weather protection as the cinder blocks are mortared and laid into place in a running bond pattern. These cores give an idea of how tall the finished buildings will be, though keep in mind the lowest exit/entry opening is the basement, which will be built out and backfilled up to ground level as construction progresses.

One of the reasons why the hot gossip swirls around Novarr’s Collegetown plans is that he enjoys a very close relationship to Cornell, so if the university determines it wants to do something Collegetown, they can turn to someone who has a lot of developable property and a strong relationship with the school. Rather than deal with the potentially damaging public blowback of a tax-exempt property, Novarr and Proujansky keep it on the tax rolls and create a welcome degree of separation. Most of their properties are fully taxed – the Breazzano, which serves an academic function rather than ancillary function like housing or student services, has a PILOT agreement for fifty years.

Apart from the excavated sites and elevator cores, the concrete foundation work (footers, slab pours, foundation walls) is ongoing, mostly at the south building. It doesn’t look like the north building is quite as far along, even though the elevator core is complete.

Project information and history can be found here.

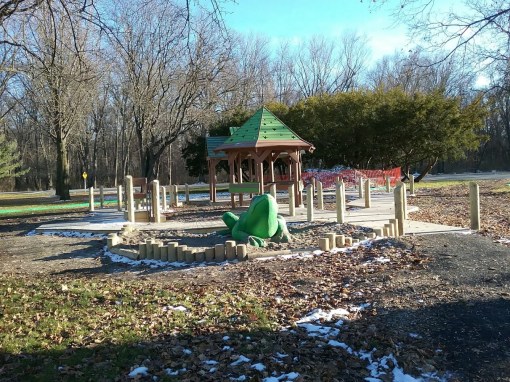

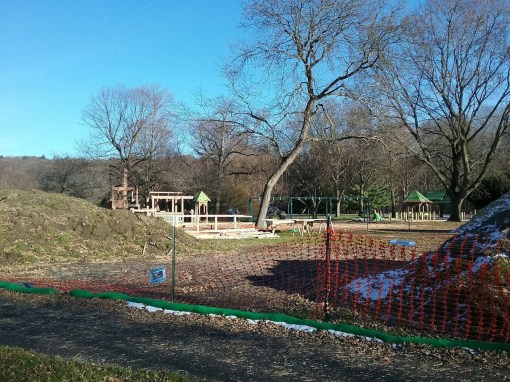

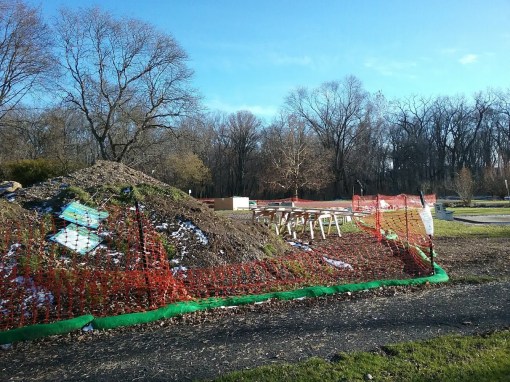

Stewart Park Inclusive Playground Construction Update, 12/2018

15 12 2018

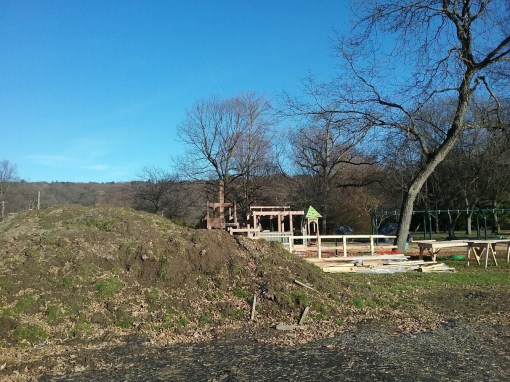

Here’s a look at the Stewart Park Inclusive Playground project. Overseen by the non-profit Friends of Stewart Park (FSP), the two-phase plan was approved by the city earlier this year, and started construction in September for a May 2019 completion. Plans for the project date back to at least 2015, with formal planning board review moving forward in late 2017. Among the features planned are (from the website):

  • A new, accessible splash pad that will conserve water.
  • Specially designed school-age and pre-school play structures.
  • An accessible berm  that provides children a starting point for exciting play experiences for all children.
  • The use of native plants and sustainable building materials and site design strategies to make the playground a model for green playground design.
  • Educational opportunities to interpret the natural environment of the park – the vegetation, birds, fish and wildlife that make this site so special.
  • Natural play areas including a music garden and sand play area.
  • Numerous swings and climbing structures, shaded seating areas and many benches for relaxing.
  • New accessible bathrooms and changing stalls adjacent to the playground and carousel.
  • A restored and accessible Carousel (completed).
  • Accessible walkways and paths linking to the Cayuga Waterfront Trail and other areas of the park and Ithaca’s waterfront.

When FSP refers to an inclusive playground, it means that it offers something for kids of all abilities – it offers a full sensory experience with lots to touch, to see and to hear. Disabled children will be able to access and enjoy much of the equipment, as well as the gardens and play areas.

Complementary additions will include a parking lot addition, benches, and bathrooms. The cost of the new and improved facilities is $1.7 million ($1,517,500 in hard construction costs like materials and labor, $182,100 for soft costs like design fees, legal and permitting, and a $50,000 annual maintenance fund). The project will take about nine months to construct, and be built through a combination of traditional paid construction crews, and volunteer community builds.

As previously reported, the location of the new structures is between the splash pad on the west end of the park and the carousel to the east, south of the transmission lines, with a total area of about 1.65 acres. The area north of the power lines is envisioned as an open play and picnicking area. With the exception of the large swings, the existing equipment will eventually be removed to near the DPW maintenance building and the ‘Whirly Bug’. The older play structure near the carousel will be moved, to another park if possible.

Three playground design and landscaping firms are involved with FSP’s plans – Parkitects, Play by Design and EarthPlay are coordinated designs and features to maximize the play value and amenities, while giving a nod to local features like rock formations and the steamboats that used to come down the lake. T.G. Miller is handling the more technical details like grading and stormwater management, and STREAM Collaborative designed the 900 square-foot storage and bathroom building.

The first phase, which includes the pre-school play area, is open, much of it thanks to the work of over a thousand of volunteers back in September, and participating organizations who sponsored volunteers and support services during the intense six-day build. Phase II will start next year, once the worst of winter has passed.

On the funding side, $1 million was received in a state grant spearheaded by Ithaca’s state Assemblywoman, Barbara Lifton (D-125th). The remaining $700,000 is being raised through a capital campaign. At last update, $658,082 had been committed by private sources. The big donors are listed here, and if you want to help close the gap in the home stretch, the donation link is here. A specialized fundraiser for the new accessible surfacing materials (a safe, durable material on which wheelchairs can move) for the playground is here.
