News Tidbits 3/31/18: A Bit of a Lull

31 03 2018

1. In Lansing, a local developer seems to have gotten the message when it comes to a small senior housing project. As reported by Dan Veaner at the Lansing Star, the latest version of Eric Goetzmann’s Lansing Meadows calls for 20 2-bedroom units ~1500 SF (square feet) each in ten buildings along a loop road, “Lansing Meadows Drive”. The project uses the entire parcel, with the eastern end set aside for a small (less than 2500 SF) neighborhood retail component.

Goetzmann is less than happy with the latest version, saying that financially it doesn’t work, but he needs to get something built to fulfill the requirements of the BJ’s tax abatement in 2011 – the senior housing component of the project has been delayed so long, the county has prepared legal action to recuperate abated taxes if Goetzmann doesn’t get the senior housing started ASAP. The answer at the last pair of meetings went from “I just want to get this done” to “We’re looking to build 12 units and if we’re successful we’re looking to build some more, which really didn’t bode well for negotiation – at this point, a low or breakeven ROI is a price Goetzmann is willing to pay over paying the county and village millions. The Planning Board is satisfied with the newest design, and a vote to approve a special permit to start construction could be as soon as April 9th. The actual construction docs would take ten weeks and the project has to go out to bid contractors, but Goetzmann is optimistic the units will be built this year.

It’s a quiet month otherwise for the village, with a cell tower and a parking lot expansion the only other things on the latest agenda.

2. Let’s take a quick look at some noteworthy sales from the past month:

The Belleayre Apartments at 702 Stewart Avenue sold for $5,434,500 on the 22nd. The seller was Sebastian Mascaro, who some readers might remember because he previously owned the Chapter House before it burnt down. The buyer was Kimball Real Estate. The 44-unit building, which retains classic Collegiate Gothic details popular when it opened in 1933, is assessed at $3.85 million. Mascaro had paid $4.25 million for the building in November 2011. Don’t expect any big changes here, but it’s evidence of the strength of the local multi-family market.

9 Dart Drive, a 4.56-acre vacant parcel in the village of Lansing, sold for $52,500 to VPA Development on March 22nd. Yes, there is something planned here – the village Board of Trustees is aware. VPA Development’s mailing address is the same as local businessman Nick Bellisario, who is building warehouses on Hall Road in Dryden, and is a partner in the Varna Tiny Timbers (The Cottages at Fall Creek) project. Zoning here is the village’s Medium Density Residentialsingle-family and two-family homes, schools and religious facilities. Zoning is one unit per 20,000 SF for a single-family home, 25,000 SF for a duplex. So in theory, perhaps 8 or 9 home lots if single-family.

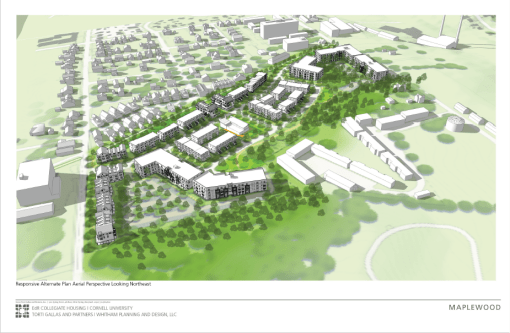

3. One of the questions that makes a fairly regular appearance in the inbox – will Maplewood finish on time in July 2018? It’s a good question, one that Cornell and EdR are damn determined to give a yes answer for. To make up for weather delays and other issues, the Maplewood construction team is requesting to do interior work to as late as 10:30 PM Monday-Friday. Keep in mind, this is on top of the Saturday hours and previous workday extension (four hours, two on both sides, to 7 AM – 7 PM). The town of Ithaca, which has to approve these changes, seems amenable to it so long as no generators are operating, doors and windows are closed, and supervisory staff is present – basically, don’t disturb the neighbors.

At last check, unseasonably cold and wet weather over the past several months had led the project to fall behind, and subcontractors to move to steadier jobs elsewhere. The project has fallen as much as 25 days behind schedule. The extensions, if approved, would create an 85.5 hour construction week, manned by different crews.

Side note, the town of Ithaca hasn’t had much else to review lately – the planning board has only had two meetings out of the scheduled six so far this year. The other projects were a single-family home lot subdivision on Trumansburg Road, and renewing the approvals for New Earth Living’s 31-unit Amabel single-family ecohousing development on Five Mile Drive. I have not seen anything underway when I’ve driven by, and the website has not been updated in a while, so it’s nice to know that something is still in the works.

4. For good housekeeping – things are slow in Dryden, so slow they cancelled their monthly planning board meeting. Things are also fairly slow in the town of Lansing, where the big controversy is a plan to relocate the shooting range for Lansing Rod & Gun. The issue is that environmentalists have criticized the gun shot’s proposal for lead shot remediation, as well as saying the range is too close to Salmon Creek. The town is still reviewing documents and has yet to make a decision.

5. Recently, the Collegetown Neighborhood Council floated a Business Improvement District (BID) similar to the Downtown Ithaca Alliance. The reception was lukewarm, according to the Times’ Matt Butler. It’s not that the concept is disliked, although some smaller property owners are a bit nervous about being outvoiced by bigger players. It’s more a concern that a BID would likely be financed by a property tax surcharge, something that the county’s (and arguably, one of upstate’s) most expensive neighborhoods would rather not have to deal with. A DIA-type group may engage in security, local beautification, event planning, or other needs as the business owners as we see fit; as of now, it’s still just a hazy idea, but we’ll see what happens with it.

6. The relative quiet in the project pipeline extends to Ithaca City. At the February planning board meeting, U-Haul corporate had submitted plans for a 5-story building that, in the words of Matt Butler, “they kicked that idea to the curb….just bludgeoned the dude.” Apparently it was too much – too big, too tall, no attractive. Also, the project for 207-209 First Street is not as bad as initially feared. Both existing two-families will be renovated, but not torn down, and a new duplex would be built at the rear of the property lots. The board says it could be similar to the Aurora Street Pocket Neighborhood, and was supportive of the plan overall.

This month was one of the quietest meeting agendas I’ve seen in years – the only project up for formal review and approval was the Stewart Park Inclusive Playground, as well as updates on the Chain Works District zoning, and the City Harbor plans. City Harbor was a late addition. There is plenty in the pipeline, some of which will come forward in the next few months; just seems there’s a bit of a lull at the moment.

7. Just a reminder – meetings for the East Hill Village neighborhood-scale proposal will be held at the The Space @ Greenstar on Monday 4/9 (an update of the past several months, 4/11 (workshops for concept designs), and 4/12 (presentation of preferred concept designs and alternatives). All meetings will be 6-8 PM, and the public is encouraged to attend.

Here’s a copy of the presentation from last May’s meeting – not anything groundbreaking, but it makes it clear that Cornell’s land holding are much more patchwork than folks might realize. I suppose the owner of the East Hill Car Wash stands to make a pretty penny at some point.

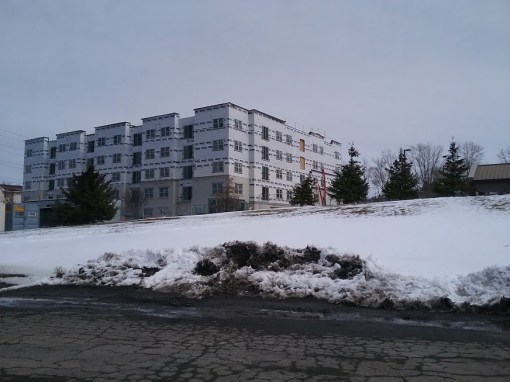

Amici House Construction Update, 3/2018

24 03 2018

Ithaca’s housing woes are fairly well-documented at this point. As in any broad situation, some have fared worse than others. If you’re fairly well off, the rapidly increasing housing prices are a nuisance, a vague political “issue” or perhaps even an opportunity if one thinks they know the market. For those will meager or no means, it’s more dire than that.

Take for instance those who are housing insecure or homeless. With a scarcity of options in Ithaca, many of Ithaca’s most vulnerable are at risk of living on the streets, with many ending up in “the Jungle” encampment behind Wal-Mart. Local shelters and supportive housing facilities are at full capacity, with dozens more turned away. This can perpetuate unemployment by reducing life stability, and it contributes to substance abuse and mental health issues. The high cost of housing has contributed to a much higher homeless rate in Tompkins County – up to five times the rate of Onondaga County (Syracuse), according to a 2016 Ithaca Voice study.

Tompkins Community Action, T.C.Action/TCAction for short, is well-aware of the issues faced by the less well-off in the Ithaca community. The non-profit started as the local unit of Lyndon Johnson’s “War on Poverty” programs in the 1960s. It administers early childhood education programs (Head Start), GED assistance, energy service programs (home weatherization), food pantries, family reunification services, housing vouchers, a fiscal literacy program, employment help – basically, social support services for thousands of low-income individuals in Tompkins County and adjacent communities, helping them succeed in their educational, professional and family endeavors.

In the past few years, Tompkins Community Action has made significant efforts to try and create more housing for those vulnerable, so that they’re less likely to end up in the Jungle or a back alley. In safe, secure housing, they are more likely to get clean, they are more likely to earn and keep steady employment, and they are more likely to take advantage of TCAction’s other supportive services, hopefully continuing on to better, more productive lives.

One of these efforts is a partnership with Finger Lakes ReUse – the pair, with consultation from affordable housing provider INHS, are entering the grant-writing phase for 22 studio units for those transitioning out of jail as well as the formerly homeless at FLR’s property at 214 Old Elmira Road. The other major project is Amici House.

Going through my archived notes, the first reference to what would become Amici House shows up all the way back in September 2014 as a 14 or 15-unit townhouse proposal, but it wasn’t until June 2016 that the first plans were presented, after a feasibility study was completed. Site plan review began in October 2016, and the project was approved in January 2017.

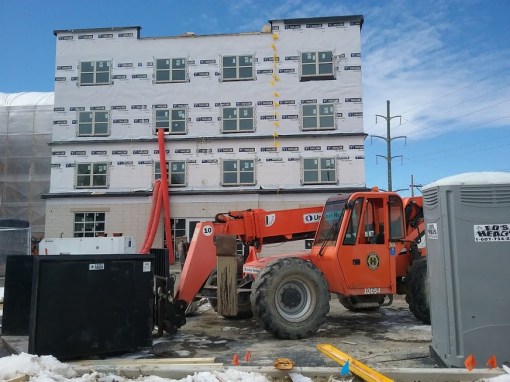

The plans, drawn up by Schickel Architecture of Ithaca, call for a narrow five-story, 20,785 SF (later 20,712 SF) building for housing, and an adjacent one-story, 7,010 SF building that will host classrooms and daycare facilities. The facilities would be a part of TCAction’s campus at 661-701 Spencer Road on the south end of the city. Two small houses would be deconstructed to make room for the classroom building, while the residential building, planned to house homeless or vulnerable youth aged 18-25, would be an addition onto the non-profit group’s existing office building.

On the first floor of the new residential building would be a children’s playroom (for homeless youth with children), case conferencing rooms, training rooms and kitchen space. 23 efficiency (studio) apartments would be built on the second through fifth floors.

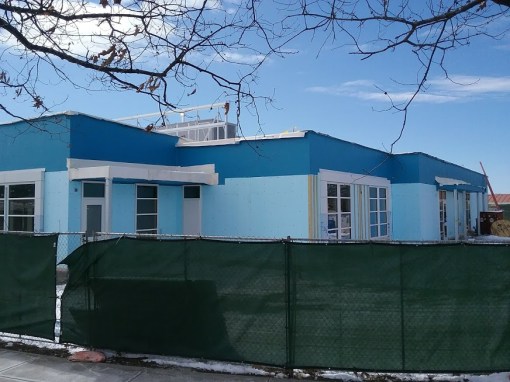

The childcare building, later called the Harriet Giannelis Childcare Center in honor of a late staff member of TCAction, will provide five classrooms for Head Start and Early Head Start programs, as well as support space and staff training space. The building will host a playground, which is the blue space in the site plan above. The facility would have space for 42 children, and create about 21 living-wage jobs. The numbers were more recently revised to 48 children and 24 jobs. TCAction, which employs 104 people, is a certified living-wage employer.

During the review process, not much changed. On the residential building, the planning board thought a glass-encased stairwell was thought to produce too much light, so the next iteration had it completely bricked in, which the Planning Board also disliked, as was a plan with small windows. Eventually, a “happy” medium was reached for medium-sized windows in the stairwell.

The project required a couple of zoning variances. The first one was for parking spaces (72 required, 65 planned). TCAction suggested that from a practical standpoint, they wouldn’t need a parking space for every housing unit, but the classrooms and office space will meet their parking requirements. Another variance was for operation of a child care facility is a residential zone, and there were three area variances related to building size and the driveway/drop-off area.

The initial estimated construction costs are $8.25 million. Per city building permit docs, The Harriet Giannellis Childcare Center’s hard costs are estimated at $1,267,479, while the 23-unit residential portion’s hard costs are estimated at $3,627,333. However, city IURA statements sat the HGCC will cost $1,774,470 to build, with $153,450 in soft costs, and a total of about $2,103,000. The residential portion comprises $6,115,000 in hard/soft costs and land acquisition (total for both $8,218,000). Welliver of Montour Falls is the general contractor.

As one might tell from above, financially it’s a bit confusing. This isn’t a traditionally-financed project with concerns about a lender’s Return On Investment. To make it become a reality, it uses a fair amount of subsidy layering – different funding grants from the city, county, NYS and the Federal HUD.

One grant, awarded in June 2016, was for $118,000 from the county that would purchase the small house next door to their headquarters – 661 Spencer, built in 1950 by the Amici family – thus allowing them to procure the land needed for developmentA later “grant” forgave the remaining $75,000 loan balance on their headquarters, and $225,000 was awarded to the project by the Tompkins-Ithaca-Cornell Community Housing Development Fund (CHDF).  TCAction first acquired their HQ with the help of the county back in 2001, and the cost of the purchase was being paid back to the county in the form of a 20-year lease. $84,200 was awarded to the Childcare Center by the Ithaca Urban Renewal Agency in 2017.

New York State awarded the project $3.732 million in April 2017, and the state’s HUD equivalent, NYS HCR, supplied another $3.26 million in two other grants, the Community Investment Fund (CIF) for the childcare center, and the Housing Trust Fund (HTF) for the housing. M&T Bank is providing a $501,883 construction loan, and another $300,000 came from a Federal Home Loan Bank.

More recently, the numbers were revised to $603,000 for M&T Bank and the NYS HCR CIF was reduced from $1.499 to $1.325 million – probably a case where the state decided not to award the full request, and TCAction had to make it up elsewhere. Funding for the Head Start operation comes from the Federal Department of Health and Human Services, and other funding comes from state and local allocations. The facilities are tax-exempt. A look at the finances, which practically break even (slight profit actually) can be found here.

Initially, construction was supposed to be from August 2017 to October 2018, but the time frames were shifted back a few months due to financial and bureaucratic snags. TCAction also discovered they couldn’t stay in their headquarters as construction went on, so they needed an emergency $90,690 loan from the IURA to rent temporary offices at 609 West Clinton Street.

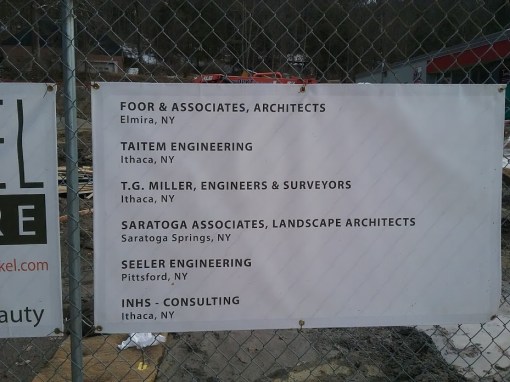

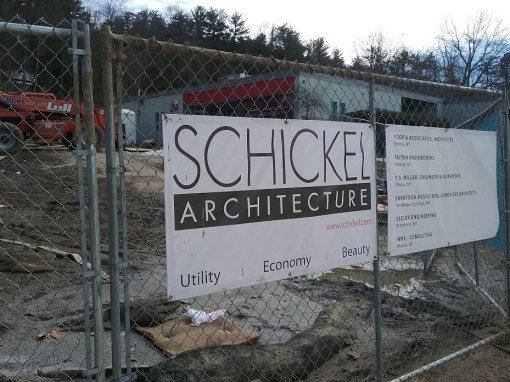

Along with Schickel Architecture and Welliver, the project team includes Taitem Engineering for structural engineering work, Foor & Associates of Elmira assisting in the design work, T. G. Miller P.C. for civil engineering and surveying, Saratoga Associates Landscape Architects, Seeler Engineering of suburban Rochester, and INHS as a consultant.

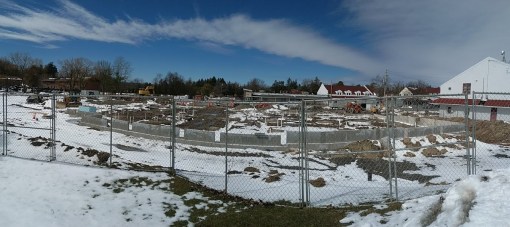

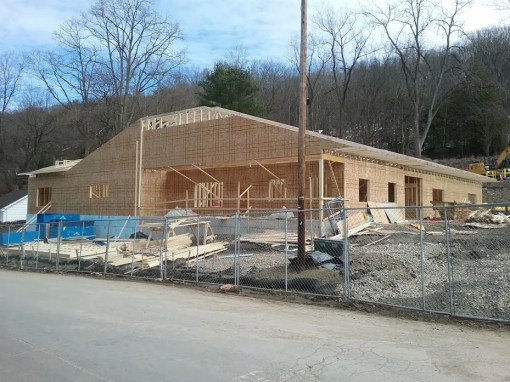

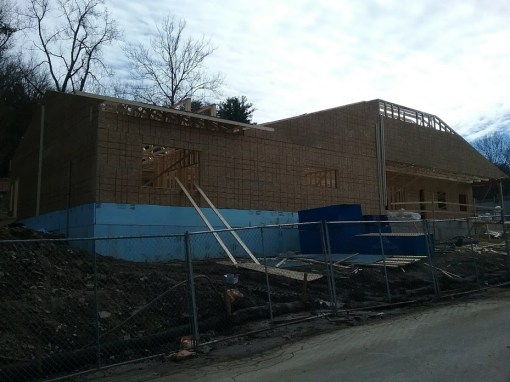

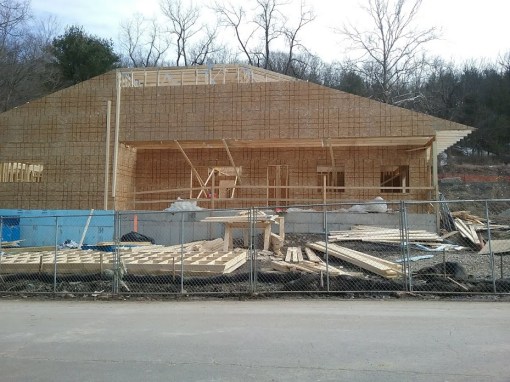

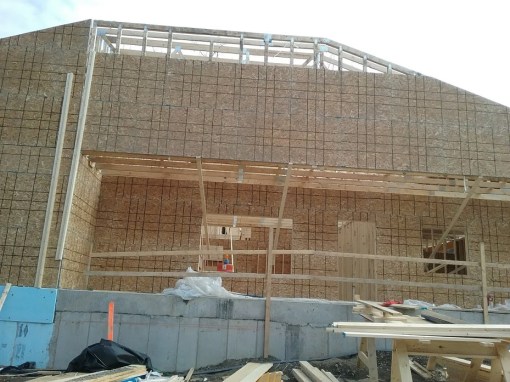

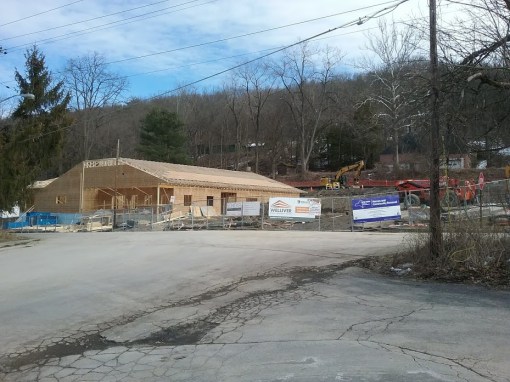

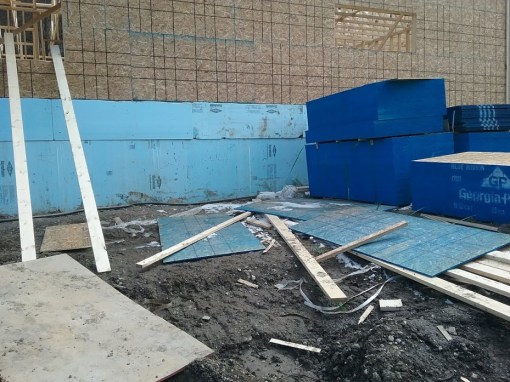

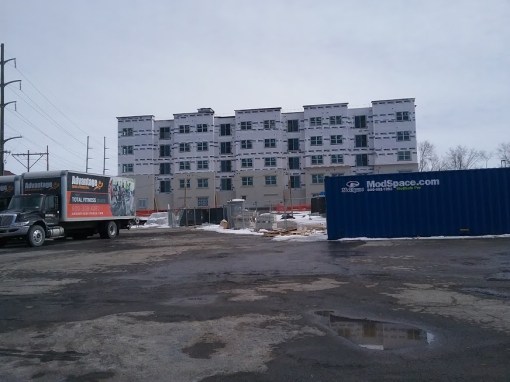

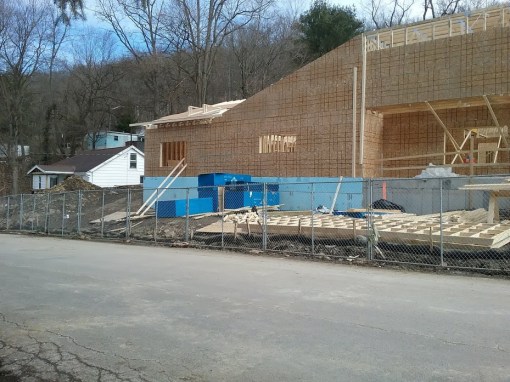

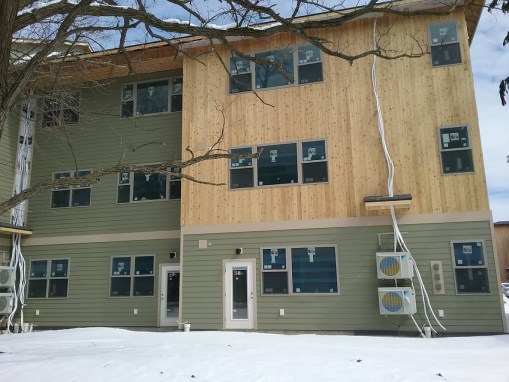

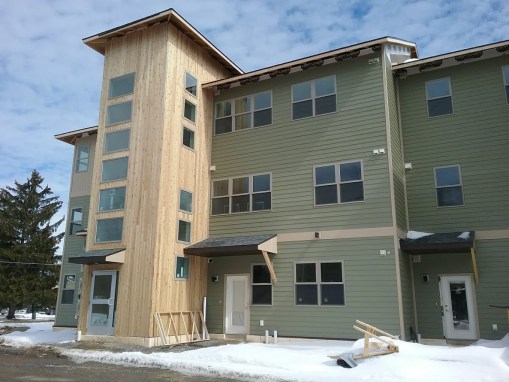

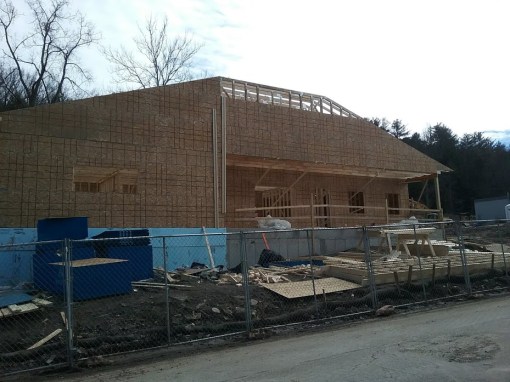

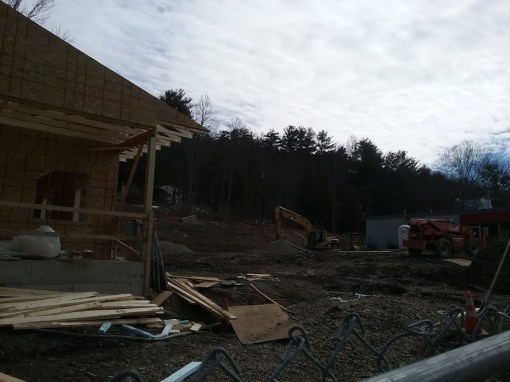

In the photos below, construction has been well underway, and has been since at least the tail end of January. The childcare center’s slab foundation and footers have been excavated, poured and insulated with rigid foam boards (the soil will be backfilled later to cover the base). The wood-frame is well underway, and it appears most if not all of the roof trusses are in place, as are many of the walls – I suppose these guys are going with housewrap instead of ZIP sheets. Although the size seems correct, the design does not look like what I have on file from , much to my chagrin. Foundation work seems to be underway for the residential portion.

Village Solars Construction Update, 3/2018

24 03 2018

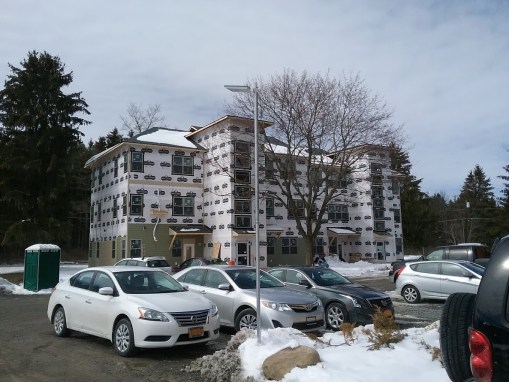

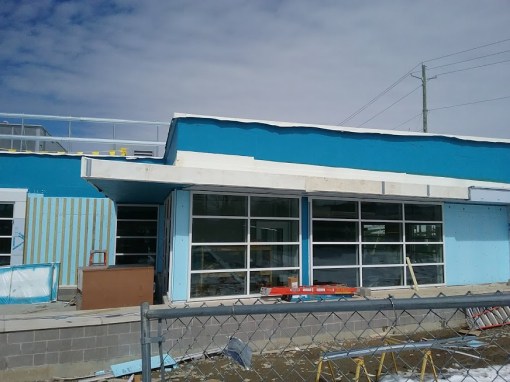

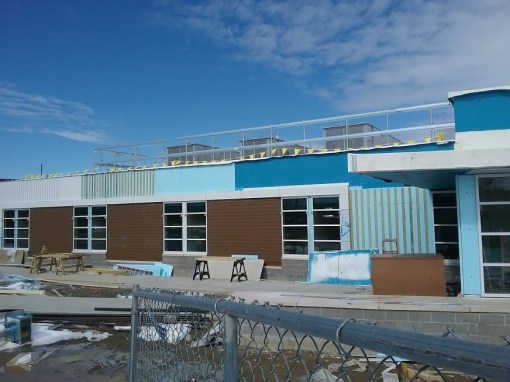

It looks like 102 Village Place is just about complete from the outside, with only some minor finishing work like trim boards remaining on the to-do list. Its peer, 116 Village Circle, is a little further behind, with rough-ins, insulation and drywall in place inside, and exterior facade work underway. The air-source heat pumps have been installed, but not fully hooked up yet. The 42 units in these two (24 and 18 respectively) should be ready for occupancy by the end of the spring.

I never caught it before, but the project docs say the developer, Lifestyles Properties (the Lucente family), will plant over 500 cherry trees on the property as phases concludes and the land is no longer disturbed. Perhaps a few of the saplings below are included in that figure.

According to the phasing plan, the next phase is to replace 2 Village Circle and 22 Village Circle with a pair of 18-unit buildings. Those would be twelve studios and six two-bedrooms each, replacing two ten one-bedroom unit buildings (net gain of 28 residents, for those keeping in track). These would likely start later this year for a 2019 completion.

After that time, Phase 3b, a 20-unit, 20-bedroom mixed-use community building (building “F”, all-new), would also start construction, with the start of phase 4, the 24-unit replacement of 36 Village Circle, to follow in the 2019-2020 timeframe. 3b has to start before Phase 4 if even just one day sooner, as that was added as a stipulation by the town planning board before any new phases commence (presumably, it would also have to be completed in reasonable time). Lifestyle Properties says the two buildings per year phase-in works well for Tompkins Trust Company as lender (its market segment and location can comfortably absorb another 42 or so units every year), and for the in-house construction team and preferred subcontractors. Spring 2022 is the practical conclusion, but there are plans for additional buildings east of the current site, which could add a few hundred more units throughout the 2020s.

Just as a subjective observation, there has definitely been a change in Lansing’s development pattern. It’s still fairly suburban, but the numerous 3,000 SF Cardamone homes that seemed to be ever-underway on cul-de-sacs in the mid 2000s have now been reduced to a trickle – I never see more than 2 or 3 underway at any one time these days, and driving through Cayuga Way, Woodland Park and Whispering Pines is often a waste of gas. However, multi-family is taking off in areas with sewer access, like here at the Village Solars, and with the English Village / Cayuga Orchard properties between East Shore Drive and Triphammer Road. Likewise, the village is getting plenty of infill on its vacant parcels, from large projects like the Bomax Drive Apartments and Cayuga View Senior Living, to smaller ones like Triphammer Row.

There’s some evidence to back that up – according to the federal HUD Building Permits Database, from 2003-2006, Lansing town and village approved 187 single-family homes and not a single multi-family unit. From 2013-2016 (the latest available), the two approved 92 single-family homes and 148 multi-family units.

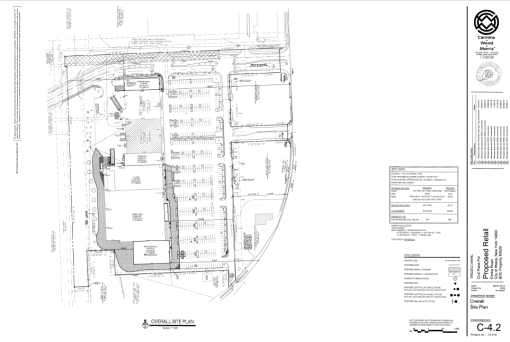

South Meadow Square Construction Update, 3/2018

23 03 2018

One doesn’t have to look far to see retail is taking in on the chin. Wikipedia has a well-sourced listicle of events in the “retail apocalypse“, as it’s been branded by the national media outlets. Several factors play into the spike in retail chain bankruptcies and closures across the country – the rise of Internet shopping (Amazon) and easy, cheap distribution, Wal-Mart and other megachains exerting economies of scale on other retailers can’t afford to sell as cheaply, younger generations buy less “stuff”, the United States simply has too much retail space.

For now, some retailers are more immune than others – those who focus on convenience and budget necessities (dollar stores), those who sell goods that are hard to ship (home improvement stores, wholesale clubs), and those who focus on experiences rather than items. However, even sectors that were once seen as safe as starting to feel the pinch – pharmacies and grocery stores, for instance.

With all that in mind, it seems a bit odd to be building new suburban “big-box” retail space, but Buffalo-based Benderson Development is doing just that at South Meadow Square at 742-744 South Meadow Street on the city’s southwest side. Benderson purchased the retail strip from the original developers (the Visnyei family) in 2009.

Development of Ithaca’s big-box corridor has always been contentious. Long ago, the area consisted of a few small auto-centric businesses and the county fairgrounds (hence Fairgrounds Memorial Parkway). During the mid and late 20th century, big box retail slowly made its way into the southwest part of the city – what’s now Finger Lake Reuse on Old Elmira Road was built as a grocery store in the 1970s, and parts of Ithaca Plaza next door date to 1950. Wegmans opened a store in the 1980s, and replaced with newer, larger store in 1997.

The 1990s was when big-box development pressure seemed to come to a head. Wal-Mart was stymied for years thanks to neighborhood opposition, and Target eventually gave up its plans and moved to Lansing. But, much to the city’s chagrin, the 1990s were difficult times economically – the tax base was in decline, state aid was in decline, and the local economy was mired in a deep recession. Somewhat begrudgingly, the Nichols (1989-1995) but especially the Cohen administration (1995-2003) began permitting large-scale retail development in the hopes of propping up the tax base and stemming the flow of dollars to suburban outlets in the suburbs, as well as Elmira and Cortland.

Many of the  city’s big boxes are result of that late 1990s/early 2000s wave. Wal-Mart (2005, expanded to a Supercenter in 2011), Home Depot (2003), the Tops Placa (2002). Some were all-new, others were extensive renovations and rebuilds. This particular retail strip at 742-744 is one of the latter – it had actually opened as a rather large 87,000 SF K-Mart in the 1970s (the 22,000 SF supermarket it shared a lobby with later became Staples), and was extensively renovated and in the mid-1980s and in more recent years. The K-Mart looked pretty dated when it closed in October 2011. Hobby Lobby filled some of the old K-Mart space in 2013, and in fall of that year, plans were drawn up for a pair of endcap expansions.

One was on the north end – 7,315 SF of retail space, next to the early 2000s 19,000 SF PetSmart. The other was a 14,744 SF south endcap that would be built were K-Mart’s garden center used to be. These plans were approved in November 2013, but then updates and revisions were proposed in 2014, when TJ Maxx and Five Below were announced to fill the remaining vacant space (21,770 SF and 8,209 SF respectively). At that time, the southern addition became 16,200 SF.

For one reason or another, Benderson decided to go back to the original plan (probably a potential tenant backed out) early last year, and asked for re-approval of the November 2013 additions – city approval is only good for two years. Unlike most parts of the city, the lack of nearby residents and general apathy towards big-box retail makes variances somewhat easier to receive; plus, a re-approval is typically a small matter – re-approval was granted in May. City zoning (SW-2, and PUDOD) is generous down here because the city keeps hoping someone will do walkable mixed-use, but the waterlogged soils make that difficult – you either build shallow, or quite deep, and quite deep requires a lot of height and square footage above ground to make up those construction costs.

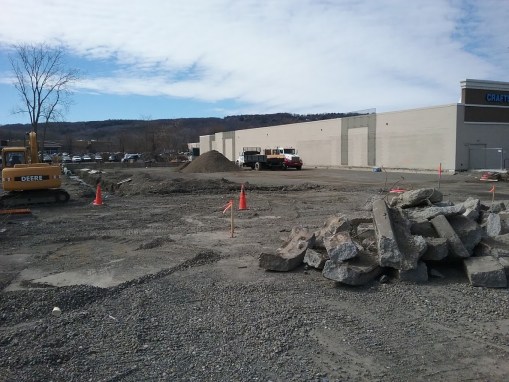

Construction is going to be fairly standard – concrete slab foundation, steel frame, masonry walls, and probably some decorative entry bays and facade work. At the moment, excavation is underway for the footers of the foundation on the southern end, while the footers have already been poured and strengthened with rebar on the northern end. The Dryvit and brick veneer on the wall of Pet-Smart has been removed, and I think that’s mineral wool insulation underneath. Expect both of these to be finished towards the end of the year. I don’t have a project value offhand, but the existing plaza (128,582 SF) is $6.5 million, so 22,059 SF of new space is probably worth about $1 million or so.

As for tenants, your guess is as good as mine. We’ll see if Benderson can make it work in the age of the retail apocalypse. Benderson’s proffered choice of designers, Buffalo’s Carmina Wood Morris D.P.C., is the architect.

November 2017

January 2018

March 2018

Cayuga Medical Associates Construction Update, 3/2018

22 03 2018

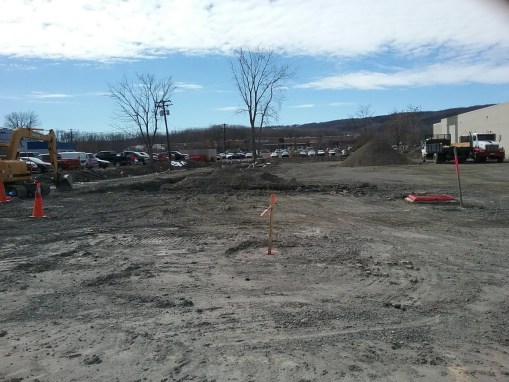

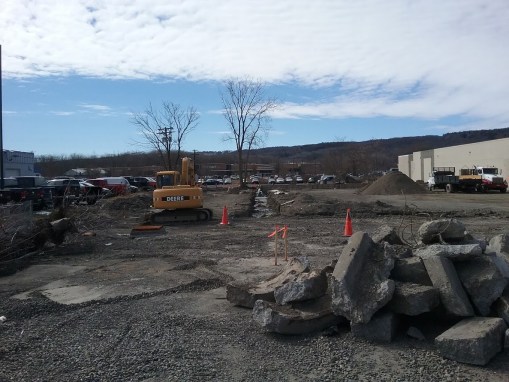

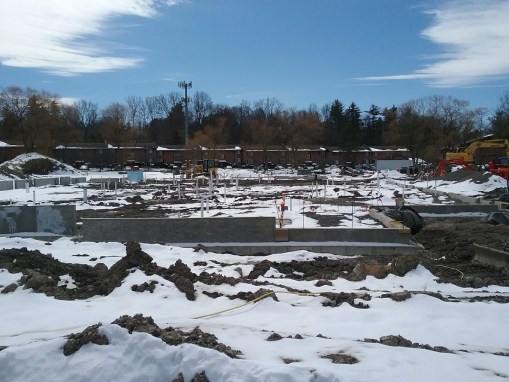

Since January, it looks like all the foundation footers have been poured and the underground utilities connections are in place. At this point comes the foundation slab itself. with a generous helping of steel rebar grid for strength. Being medical office, this is probably a steel frame construction, so visitors to Community Corners can expect that later this spring. McPherson Builders should have the $7.8 million building ready for commercial occupancy by late summer.

In the meanwhile, visitors can also look forward to the new Gimme! Coffee that is planned for the closed Lonacakes Bakery space. That new business will bring 5-10 living-wage jobs; readers might remember that the baristas recently unionized. There is a modest little cafe and catering place nearby and the swanky Heights Restaurant, but it’s probably safe to say that the niches are different enough that Gimme! won’t poach business from the others.

I remain a bit hopeful that eventually, Cayuga Heights and relevant property owners (Tim Ciaschi, Mark Mecenas) might nudge towards the denser if still relatively modest mixed-use plan that was proposed five years ago; Mecenas said at a recent meeting he’s still interested. In other village news, staff say there have been several inquiries into the former Tau Epsilon Phi fraternity property a mile away at 306 Highland Road, but no takers as of yet.

Cornell Veterinary School Expansion Construction Update, 3/2018

21 03 2018

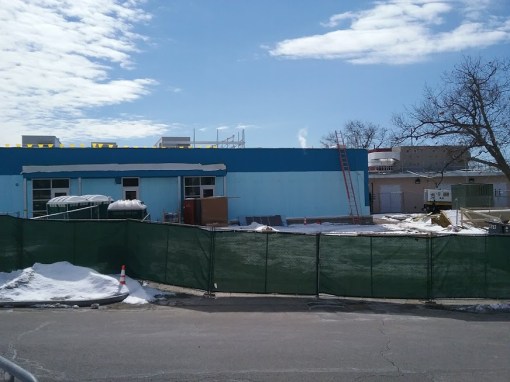

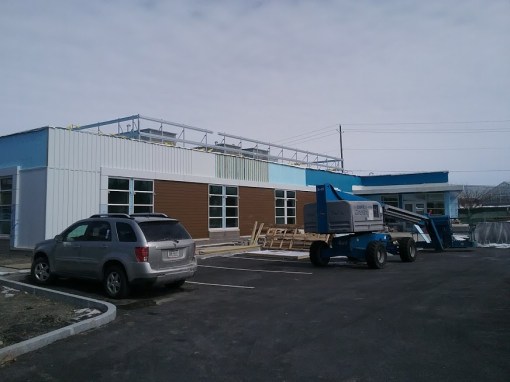

The Cornell College of Veterinary Medicine’s new Community Practice Service is set to open in May, and it certainly appears to be in the home stretch. Exterior finishes are underway. Atop the dark blue water-resistive barrier are rigid foam insulating panels, and what appears to be a combination of corrugated steel panels (probably Morin or a similar brand), Alucobond aluminum composite trim panels and simulated wood fiber cement boards. These materials have made or are making appearances on other recent builds as well – HOLT Architects, the designers of the new CPS Building, also incorporated corrugated metal and flat aluminum panels into 210 Hancock’s multi-story apartment block. Meanwhile, wood-like fiber cement shingles will be used as one of the finishes on The Lux apartments at 232-236 Dryden Road.

It seems a little strange that the “clips” on which the wall panels will be fastened are wood instead of steel. Perhaps since the exterior finishes are light, waterproof and will be sealed tight, it’s an acceptable choice. The frame for the rooftop mechanical screen is in place, and the flag strings suggest that the roof membrane is being laid. If you look closely enough through the windows, you can see steel interior stud walls and HVAC ducts. Compared to the renders, there only seem to be a few minor differences in materials and appearance (the corrugated metal panels, and maybe the fenestration over by the entrance).

According to HOLT’s project webpage, the $7 million project is aiming for LEED Silver Certification. Here’s the building description from their webpage (which, kudos to the HOLT website manager, because not many architects include their buildings currently underway):

“The new 11,000sf Community Practice Service Building, is a stand-alone veterinary clinic and teaching facility that will provide a real-world veterinary practice to the surrounding community.

The new building design includes a welcoming waiting area, as well as veterinary surgery, imaging, and exam rooms; procedure induction/recovery, and animal holding areas; lab and pharmacy spaces; staff and faculty offices, conference rooms, lockers, restrooms, and other support spaces.

Once complete, this building will be a beacon for pet health and wellness in the community and on campus – with the architecture exemplifying the quality of learning and client service that will happen within its walls.”

Cayuga View Senior Living Construction Update, 3/2018

20 03 2018

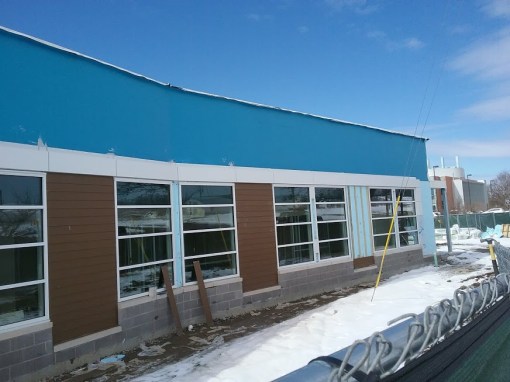

It looks like Taylor the Builders has started attaching exterior finishes to the Cayuga View Senior Living apartment building. That includes decorative cornices, brick veneer, and what appears to be a few different shades of EIFS panels. EIFS (Exterior Insulation Finishing System), sometimes called synthetic stucco or by commercial brand names such as DryVit, is a lightweight, waterproof finishing material – usually it’s two-inch thick polystyrene (rigid foam) insulating panels with an acrylic finish to mimic the appearance of stucco, along with adhesive and drainage structures. EIFS is low-maintenance; it gained popularity in the 1970s and 1980s, but developed an infamous reputation for water damage due to improper installation, which is why so many building codes are stringent about adequate drainage systems for new builds. The boards can also be damaged fairly easily by blunt-force impacts. It tends to be more common on commercial buildings than residential structures, but it is not an uncommon choice of finishes for wood-frame multi-family buildings. Other recent builds using EIFS include the Holiday Inn Express on Elmira Road, and the Seneca Way Apartments on the edge of Downtown Ithaca.

Interestingly, the top floor’s panel boards are a lighter color than the third floor – renderings have them both being the same color.

Also, note the poles and flags on the roof – that’s a good indicator that some material is being applied, probably EPDM, which is a synthetic rubber. The project team recently announced that the 87,500 SF building will not only host a rooftop garden, but a 46kW, 151-panel solar array courtesy of installer SunCommon NY of Rochester.

Current plans call for the first occupants to begin moving into its 60 apartments by the end of May (the website advertises a summer occupancy, and a leasing office is present on-site). Cornerstone Group, also of Rochester, has been selected to manage the building, whose units are reserved for those aged 55+. I’ve been in touch with the project team, and there might be a sneak preview article in the Voice a few weeks before opening.

News Tidbits 3/10/18: Affordable Housing Week 2018

11 03 2018

For today, let’s take a look at the entrants competing for the city’s affordable housing funds.

The Ithaca Urban Renewal Agency will be holding public hearings on Thursday 3/22 and Thursday 3/29 s part of the process to determine who will receive money from the Housing and Urban Development (HUD) grants awarded to the city. The 28 applications, three more than last year, range from jobs training to community services to the development of affordable housing.

In aggregate, there is $2,042 million requested, and about $1.239 million available. For the sake of comparison, that’s a 60.6% funding vs. request ratio, slightly more than last year’s 58%, but less than the 83.2% ratio of 2016, and the 67% ratio in 2015. 2016’s ratio was high because of $273k in unspent money originally earmarked for the earlier INHS plan for 402 South Cayuga Street.

Roughly speaking:

Year    Request    Amount Available

2015 / $1.78m / $1.215m

2016 / $1.85m / $1.54m

2017 / $1.982m / $1.149m

2018 / $2.042m / $1.239m

Unfortunately, HUD funding is not going up – of that $1.239m, about $184k is carried over from 2017 – Finger Lakes ReUse decided to decline last year’s $50k award, as did 402 South Cayuga Street ($80k, Habitat for Humanity’s cancelled project) and Housing for School Success (~$34k). The other roughly $20k was unallocated funds. In truth, the award for 2018 is $1.055 million, while requested amounts continue to rise, and the head of HUD gets embroiled in scandal for, among several reasons, ethics issues involving HUD business dealings with his family, and trying to spend $31k on a dining set for his office.

Without discounting the value of the other applications, the focus here will be on the real estate development projects. A full rundown is provided by my Voice colleague Kelsey O’Connor here. For the record, writing about a project is neither an endorsement or opposition from this blog.

1. First, 402 South Cayuga Street. This site has had a rough history, unfortunately. It’s a small vacant lot just south of Downtown Ithaca that has had little good luck in the past several years. Five years ago, INHS originally attempted to build four units of for-sale housing on the property, but could not make it financially viable, as construction costs rose beyond what they could do within budget. Another developer proposed a market-rate plan, but the city, which owns the lot, has a strong preference for affordable for-sale housing. Habitat for Humanity also made an effort to build for-sale housing on the site, but it too saw construction costs rise beyond their capacity.

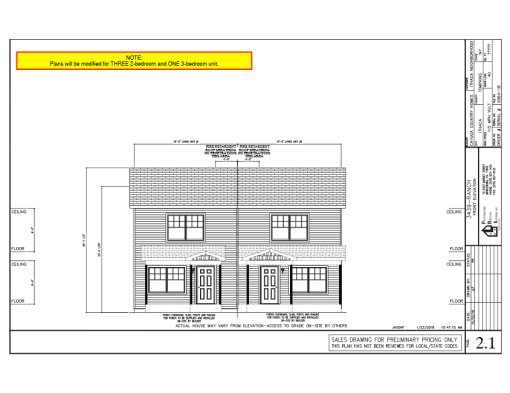

The grant application, $150,000 towards that $1.057 million project, would revive the INHS plan the planning board approved a few years ago. Two of the townhomes would sell to households making at or below 80% of Area Median Income (AMI, at or below $42,400/year for a single person), while the other two would sell to those making at or below 100% AMI (at or below $53,000/year), sometimes called “missing middle” housing. The funds would be used for construction and soft costs (legal paperwork, permit fees) on the two lower-priced units.

The reason why this is feasible now is that for one, the planning and design costs from 2013 have been paid off and the design is nearly the same, and two, the project will be modular instead of stick-built. INHS would partner with Cayuga Country Homes to build the four units. The units would be locked into the Community Housing Trust, and include features not in the previous plans, such as air-source heat pumps. However, the bay windows on the north and south walls have been removed from the new plans.

Breaking it down a little more, the construction cost would ring in at around $177/SF, about 10-15% less than stick-built. The three 2-bedroom units are 1190 SF and will cost about $210k to build, while the three-bedroom will be 1352 SF and cost about $239k to build (total about $870k, of which $830k is consumed by hard costs, materials and labor).

INHS will sell the 80% AMI two-bedroom at $121k, and the 80% AMI three-bedroom at $139k. The two 100% AMI units will sell at $159k. INHS will need to cover the remaining $291,000 with grants and subsidies just to break even. It is possible to build marginally cheaper, but insurers require INHS has to use contractors with at least $1 million in workplace liability coverage.

If funding were awarded later this spring, the units could be ready by April 2019. Although the construction method is different, the exterior changes are generally cosmetic – slightly different window arrangements, deleted bay windows, and porch details. It’s still at its essence four 2.5 story townhomes with ground-level rear garages and cantilevered rear decks. It is possible they could be signed off on at the staff level, but it’s more likely they would need to pay a quick visit to the planning board. The exterior changes could be reviewed and approved in one meeting.

2. The other INHS submission is titled “Scattered Site Phase 2: New Construction”. The request is for $100,000 to help cover soft costs (architectural and engineering fees) associated with the projects in the application. Calling them “scattered” is a little bit of a stretch – it’s two sites. One is 203-209 Elm Street on West Hill. That will have thirteen units, replacing twelve existing units, a count that includes 4-unit 203 Elm Street, currently vacant due to structural concerns. Six of the thirteen will be targeted to households at 50% AMI ($26,500/year for a single person), and the other seven at 60% AMI ($31,800/year). Ten of the units are one-bedrooms, and the remaining three are two-bedrooms.

The big question is the $16 million project planned for Downtown Ithaca. Although INHS cannot name the applicant, there were enough hints to figure it out with a fairly high degree of certainty. I can’t run conjecture on the Voice, but here, well, take the disclaimer that I could always be wrong. But consider the following:

From the notes in the application, we know it is:

  • In census tract one – mostly Downtown and the State Street Corridor.
  • The current site is a small commercial building.
  • It is in the CBD – Central Business District.
  • The site would host 20,000 square-feet of commercial space, and 40 housing units. The 30 one-bedroom and 10 two-bedroom units would be set aside for those making 30-60% AMI ($15,900-$31,800/year).
  • An unknown number of units would be set aside for formerly homeless individuals or those in need of supportive housing. The current owner would provide supportive services in the first-floor of the commercial space.
  • The partner in the project has provided services for over 150 years.
  • INHS would buy the land for $750,000.

The only site that checks off all the boxes is the Salvation Army property at 150 North Albany Street. It is currently valued at $800,000, following a $100,000 bump upward last year. A back of the envelope suggests a gross square footage of 55,000 SF, plus or minus a few percent. That would put the new build at roughly the same size as Breckenridge Place (55,300 SF).

Zoning at the site is a little odd – it’s a split, CBD-60 on the southern two-thirds, and more restrictive B-2d on the northern third. CBD allows up to 60 feet in height, 100% lot coverage no parking requirement. B-2d allows four floors, 40 feet in height, and has no parking requirement if a building is more than 60% residential use – which there’s a fairly high chance this project would exceed. I’m picturing something five or more likely six stories on State, and stepping down to four on West Seneca Street. But, there’s still a chance I could be wrong, and this may isn’t the right site.

An approximate construction time frame for the mystery project appears to be October 2019 through January 2021. A sketch plan revealing the mystery partner and site is expected to be shown to the city planning board in June. SWBR Architects of Rochester is in charge of design.

3. The last one I’ll cover is the Finger Lakes ReUse expansion. Let’s preface this by saying they don’t own the site – the former grocery store turned BOCES turned eco-services non-profit entered into a purchase agreement with John Novarr in February 2014 to purchase the building for $1.25 million (below the assessment of $1.35 million), which they will do exactly five years after the agreement was signed, in February 2019. The $100,000 requested would be assistance towards the purchase of the property, freeing up their money to work on their upcoming construction projects.

As is, the site is a 17,000 SF retail building, and a 1,330 SF former garage/repair shop. Plans have been proposed for major additions – 6,500 SF of retail, 65,000 SF of office space, and 12,000 SF of supportive housing, which consists of 22 studios for low-income individuals, with emphasis on formerly homeless and/or incarcerated individuals. Welliver, INHS and TCAction have provided guidance and assistance; Welliver may be the general contractor as construction proceeds, and TCAction may manage the housing units. STREAM Collaborative is the architect.

Point of confusion – the approved plans call for a 26,100 SF, 4-story building with mixed-use retail, office and living space components, and an 8,100 SF open-air metal warehouse for reclaimed wood processing and storage. That all totals 34,200 SF, not 83,500 SF. There’s 49,300 SF that is not clearly spoken for.

The warehouse is phase one, will cost about $500,000, and be ready by Q3 2018. It will generate at least three living-wage jobs (an estimate Finger Lakes ReUse says is conservative). Phase two is funding dependent on the affordable housing component, and will provide at least six new living-wage jobs. Although NYS HCR affordable housing grants don’t typically cover commercial space, they can be applied to mixed-use structures.

The total project cost is $10.521 million. $1.89 million of the costs are covered with a NYSERDA grants, and Empire State Development has also offered a $500,000 economic development grant. Add in other grants and awards received or being pursued, and it appears that only about $3 million will be covered through loans. IURA funding an extra $100k makes the project more competitive for other grants, since FLR will have demonstrated they have more secured funds, and a higher chance of moving forward. The idealized time frame calls for a late summer 2019 construction on Phase II with completion a year later, but sit back and see what happens with applications and awards first.

304 Hector Street Courtesy Post

7 03 2018

The following is a courtesy post sent in by Lynn Truame, Senior Real Estate Developer for INHS. 304 Hector Street, on Ithaca’s West Hill, was built in 2017 with the help of IURA-awarded HOME federal grant dollars. The 1,223 SF home is for sale for $149,000 to households making at or below 80% AMI ($42,400 for a single person, $60,500 for a family of four).

***

304 Hector Street:  Green Affordable Homeownership in the City of Ithaca

The single family home at 304 Hector Street looks like dozens of homes all over Ithaca:  an American Foursquare design with a broad front porch, located on a small landscaped lot.  But beneath that modest exterior lies something special:  a brand new LEED Gold Certified home that is affordable to the “Missing Middle”:  households earning around 80% of the Area Median Income, or less then $60,500 for a family of four.

304 Hector is the latest addition to Ithaca Neighborhood Housing Service’s Community Housing Trust (CHT).  The CHT program ensures long-term affordability for purchasers by allowing the homebuyer to only purchase the house. The land is leased from INHS under a very affordable 99-year lease, reducing the initial purchase price by excluding the cost of the land. Subsidies bring the cost to the buyer down even further, allowing CHT homes to be sold at prices that are up to 50% below market value. As the land owner, INHS retains stewardship over the project, ensuring the home remains affordable for future purchasers.

Like all of INHS’ CHT properties, 304 Hector is a “green” building. LEED for Homes, Indoor AirPlus, and Energy Star certified, this house well exceeds the minimum requirements of the building code, with special attention being paid to indoor environmental quality and resource efficiency. This green home surpasses conventional homes in four major areas:  greater energy efficiency, improved indoor air quality, better use of natural resources, and lower impact development. Building to these standards results in a home that is less expensive to heat and cool, more environmentally friendly, more durable, less polluting, and less wasteful to build.

Some of the most notable “green” characteristics of 304 Hector include:

  • Densepack cellulose insulation, made from recycled newspapers
  • EnergyStar appliances
  • Advanced air sealing and mechanical ventilation
  • High efficiency sealed-combustion boiler providing both heat and hot water
  • Low VOC paints
  • Green Label certified carpet
  • High efficiency, low-flow faucets and fixtures
  • Reduced construction waste
  • No tropical hardwoods
  • Triple pane EnergyStar windows

Completed in December 2017, 304 Hector was designed by architect Noah Demarest of STREAM Collaborative, and built by a local contractor, D-Squared Construction.  EnergyStar and LEED Rating services were provided by Steven Winter Associates, Inc.
