Harold’s Square Construction Update, 12/2017

31 12 2017

Grab a cup of coffee or tea for this one, it’s a long introduction.

Touching on a familiar topic again, downtown and urban living has enjoyed a revived interest in the past fifteen years, and coincident with moderate but steady economic growth in Ithaca, it has created plenty of opportunities for those with assets and expertise. Succeeding in those opportunities is a slightly different story – money and a strong project team are important, but some projects have an easier go of it than others. Harold’s Square has experienced substantial obstacles in its long pre-construction period, but thanks to developer David Lubin’s flexibility and tenacity, as well as an accommodating local government and growing market, it has surmounted those challenges and is now underway.

The first version of Harold Square at 123-139 The Commons was proposed back in October 2012. At the time, the plans called for first-floor retail, a few floors of office space, and 60-70 apartments on the upper floors of the 11-story building. The Sage Block (Benchwarmers) and W.H. Miller Building (Home Dairy) would be renovated, while three less historic buildings would be taken down to make way for the new development. The estimated price was $30 million and the plan was to have the 126,000 SF building finished by summer 2014. At that time, the building would have needed a fairly substantial zoning variance – the entire site was CBD-60, and it reached about 135 feet.

With the exception of the first-floor retail and Sage Block renovation, none of the other details have remained the same. However, the five major design iterations have all been by the same architect – CJS Architects (formerly Chaintreuil | Jensen | Stark Architects), with offices in Rochester and (later) Buffalo.

Lubin already had some familiarity with the project site – one of the storefronts to be removed used to be home to Harold’s Army Navy Store, a business started by his father and expanded to sixteen locations across the region. These stores were closed in the late 1990s as Lubin chose to focus on his development project and other business endeavors, like his computer recycling business. Harold’s Square is a nod to his father’s store, and the famed Herald Square of New York City.

The project design was critiqued and reviewed thoroughly over the next ten months, which also produced the first major set of design changes – in fact, if you’re googling Harold’s Square without prior knowledge, images of this version, v02, turn up enough that even many current agencies and organizations (and even the posters on the construction fence) treat it as the final design. The 2015 image from the contractor’s website, Taylor the Builders, is shown above. It did away with some of the less-liked design features of v01, but retained a clean, contemporary profile with a curtain wall of glass, and terracotta panels that extended to the roof canopy. During this period, plans to acquire the W.H. Miller Building were dropped.

This was the version that was approved in August 2013, and received CIITAP tax abatements two months later in October 2013. It had 162,750 SF, with basement utilities/storage, ground-floor retail (20,670 SF), three floors of office space (56,855 SF) and 46 apartments on floors 5-10. The eleventh floor was a 5,000 SF penthouse for tenant use. The price tag was about $38 million.

At this point, post IDA approval, we kinda enter a publicly dormant period. Publicly, apart from the occasional reassurance from Lubin that the project was still alive, and the re-application for approval permits since those expire after two years, there didn’t appear to be much going on. Behind the scenes, it gets a little more interesting.

The project was having trouble securing a construction loan, and that was for a couple of reasons. For one, Lubin (as L Enterprises LLC) was having trouble securing a major office tenant, and office space made up about a third of the building. No one had any concerns about the apartments since the residential market was (and still is) strong, and retail is not hard to sell when it’s on The Commons, but office space is a different matter altogether. The demand for new space is modest, and often custom built for a tenant, rather than speculative space to be filled by tenants after it’s complete. So if we’re being fair but critical, the project team made a fair gamble but ended up overestimating the market for office space. Unless that space was spoken for, there would be no financing.

Re-examining the mix of uses, Lubin decided to revamp the project when seeking re-approvals in August 2015 – two floors of office space would be replaced with apartments. The first mention of this actually came through the New York Times, followed by the Voice and the Ithaca Times. With the drop in office space, the number of apartments jumped to 86. This also required some design changes, which were going to be reviewed by the city in Fall 2015. My notes show August 2016 ended up being the review date. We’ll call this version 3, v03.

Now Harold’s Square was 180,090 SF, with basement utility/storage space, ground-floor retail, second floor office space, and ten floors of apartments. The project had grown from 11 to 12 floors, but the height was nearly the same since residential floors have lower floor-to-ceiling heights than Class A office space. The total unit count was now 108, with 40 micro units (all the rage these days), 30 1-bedroom units, and 38 2-bedroom units. This version was approved in September 2016. By the time the project was up for re-approval, the city zoning had changed such that 140-foot buildings were allowed on-site, so no further height variance was needed.

With the space utilization issue worked out, the project was still seen as a sizable risk to potential lenders – it was at its inception the largest project proposed in downtown Ithaca since 2005’s Seneca Place, and Lubin had some experience with smaller projects, but nothing this size. Finding a partner to buy in to the plan would reduce the loan needed and add experience, making the project an easier sell to lenders. This is where McGuire Development, a major interest in the Buffalo market (3.5 million SF), came into play. They saw the potential in Lubin’s vision and the value in the Ithaca market, and agreed to buy in as a development partner. This appears to have been finalized in January 2017.

Fast forward to May 2017. With McGuire playing a role on the project team, major design iteration #4 (v04) removed the terracotta panels in favor of metal, and reconfigured the Commons storefront retail to use a common entrance, for “financial viability”. The enclosed atrium was removed and a mechanical penthouse added. It seems likely that McGuire wanted to ensure a certain return on investment. This version was approved without much further comment, except perhaps a bit of exasperation from city officials. Concurrently, the project team re-applied to the IDA for a revised tax abatement – the project’s price tag was now up to $42 million, and they were seeking revised, slightly more generous terms, which were granted with some grumbling. Complaints include a lack of explicitly affordable housing units, local labor concerns, and gentrification. The use of heat pumps and 60 kW of rooftop solar panels assuaged the sustainability crowd.

By October, the project was underway, courtesy of a construction loan from Norwich-based NBT Bank. The bank is a regional player with about 1.5x the assets of Tompkins Trust. This is new territory for NBT, which typically limits itself to single-family home loans in Tompkins, and has no service branches within county lines. The loan is for $33,842,000. L Enterprises and McGuire have each put up $5 million to cover the $43,842,000 cost of the project.

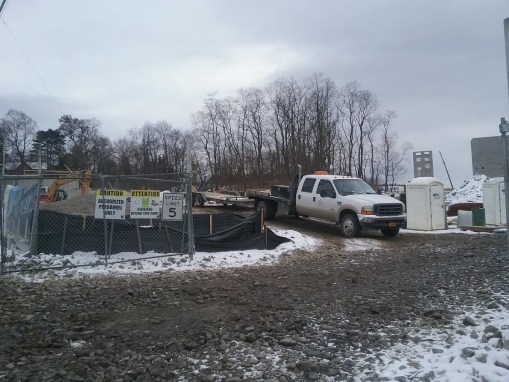

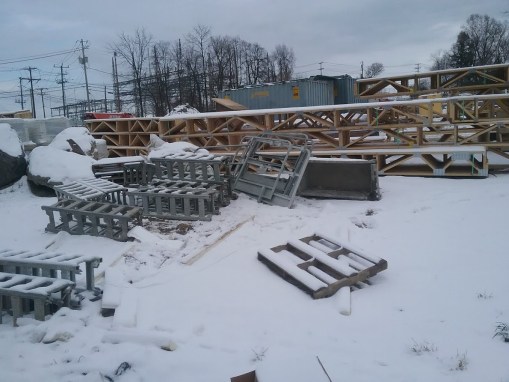

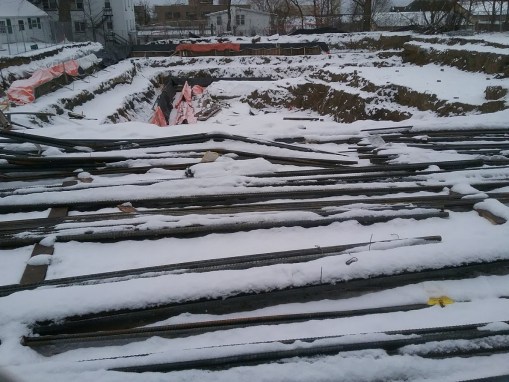

So here we are. The site has been cleared, and shoring and excavation by Paolangeli Contractor will take place over the next six weeks. After that comes ten days of pile driving, using a zero-resonance hammer to reduce vibration and noise – ostensibly, because is probably the second-most high-profile project site in the city after City Centre (which used the same method). Project completion is expected in Spring 2019. Sorry folks, but the Commons playground will remained cocooned and closed due to safety concerns.

The project team includes L Enterprises LLC (led by David Lubin) as lead developer, McGuire Development as co-developer, Taylor the Builders as the general contractor, CJS Architects, Fagan Engineers and Land Surveyors handling the application and civil/structural engineering work, and Brous Consulting for public relations. Those who want to follow the project without this blog as an intermediary can sign up for update on the project webpage here.

With the latest update on their webpage also comes the latest version of the project design, v05 – which doesn’t really affect the program space, but it does have several visual changes. The corner units now have exposed balconies vs enclosed rooms, the dark metal band on the top floor facing the Commons has been removed, and the retail frontage was reconfigured a bit on the Commons facade (the north module was stretched, one of the entry doors moved, and different fenestration patterns have been applied to some of the modules and the northwest face).

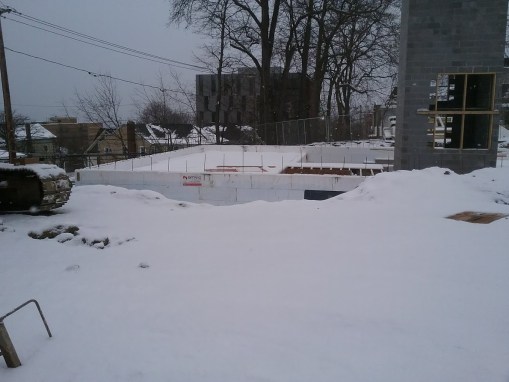

Pre-demo photo:

Maplewood Redevelopment Construction Update, 12/2017

29 12 2017

So there’s a lot going on. You can scroll through the 40+ photos below, or you can check out the conveniently placed webcam that EDR installed at all their projects. It seems like Mother Nature is out to stop this project at just about any cost – as explained by the Voice and the Times, EdR has lost 25 days of construction time due to weather (rain) delays, and that forced the project team to not only ask for extended hours earlier this year, but they also had to request earlier this month to be allowed to work on Saturdays. Now LeChase and their subcontractors have to contend with multiple days of subzero temperatures, in what is likely the longest and most severe cold snap in over a decade. It’s one complication after another. The webcams shows they’ve put up heavy-duty plastic sheeting to keep the extreme cold at bay as the crew continues work on the townhouse strings.

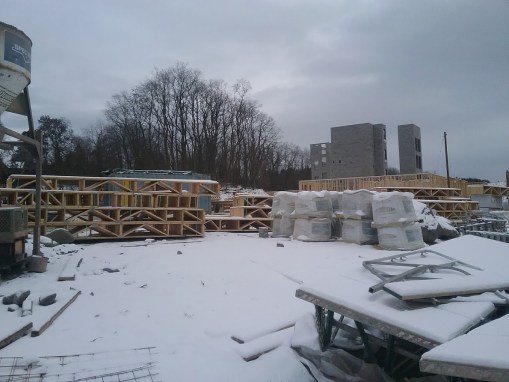

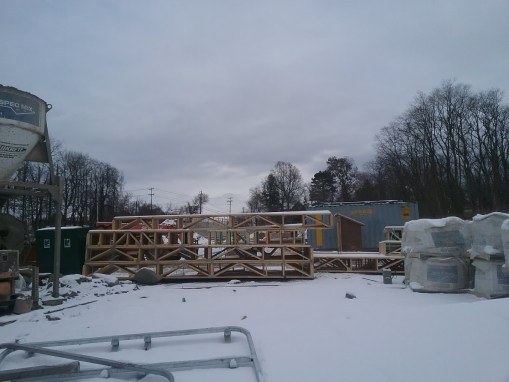

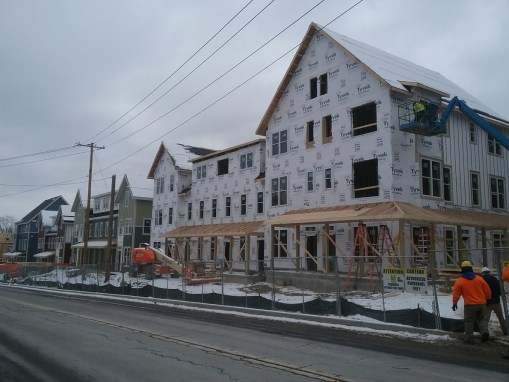

There are 27 buildings in some state of construction, from foundation work to framing to exterior facade application, and all manner of interior work from framing, to rough-ins, and for the furthest along, insulation and perhaps drywall hanging. Fixtures, primer coats of paint, and trim pieces (moldings, baseboard) will follow. There are have been some minor exterior design modifications (like the dormers in the buildings along Mitchell Street), but otherwise it’s as-approved.

More specifically:

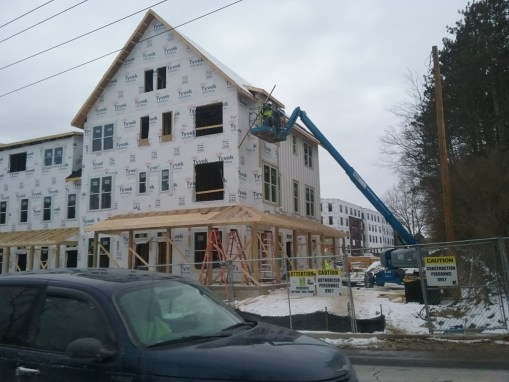

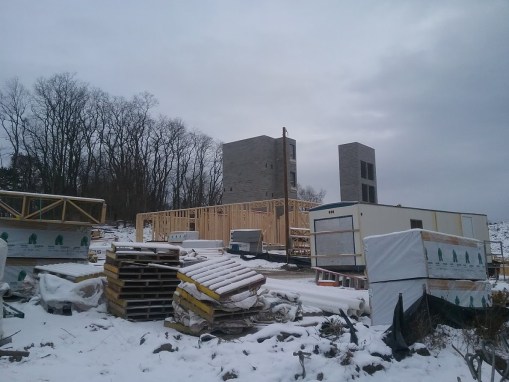

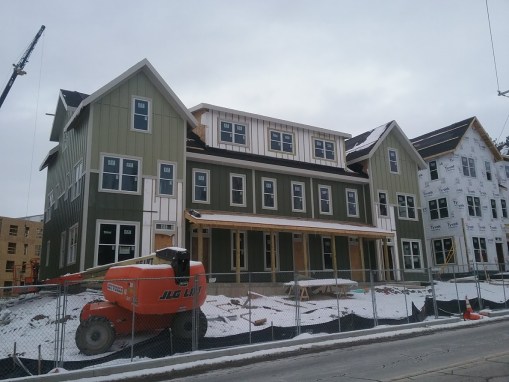

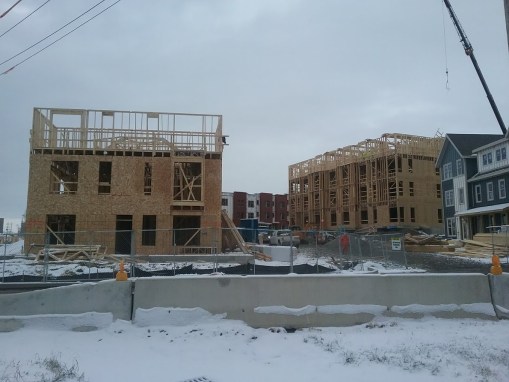

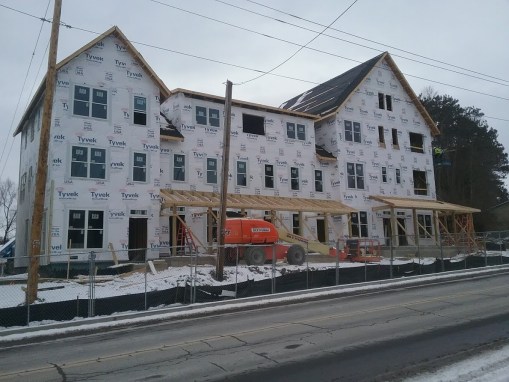

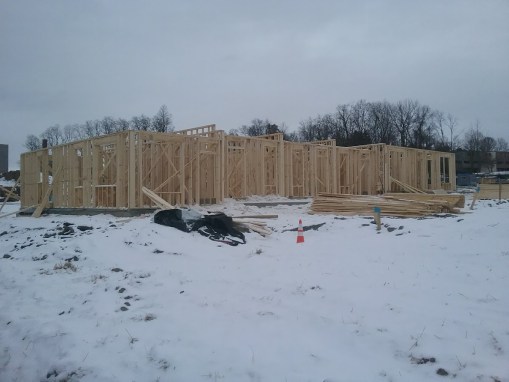

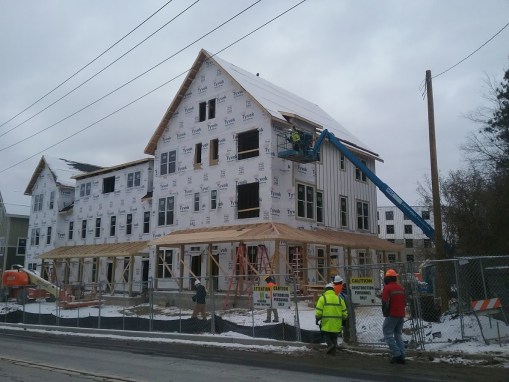

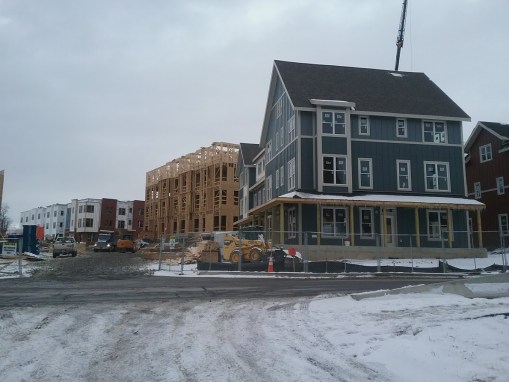

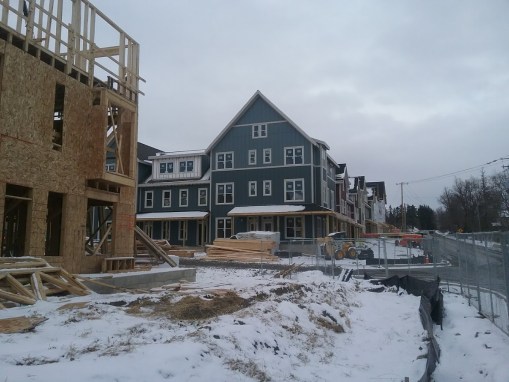

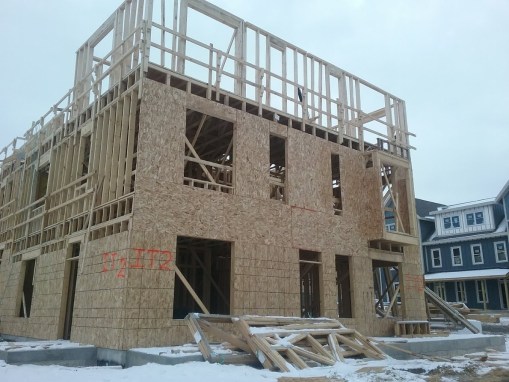

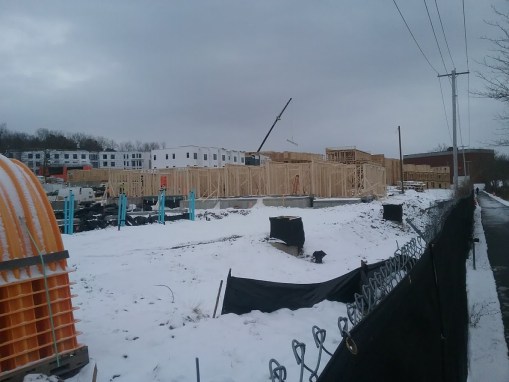

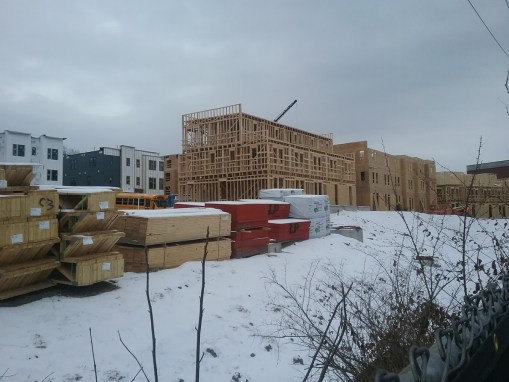

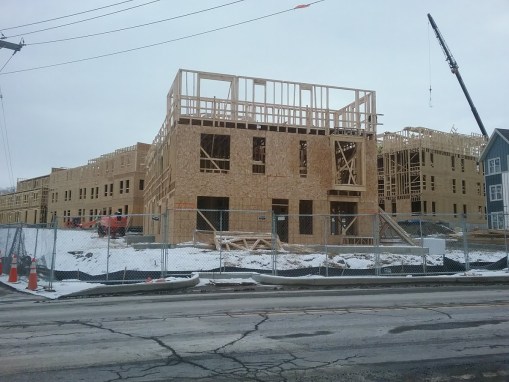

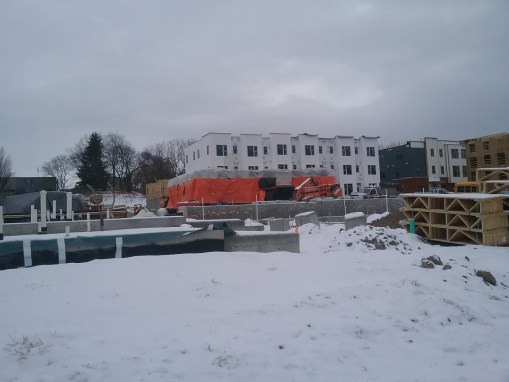

Apartment Building B: Framing (top floor)

Apartment Building C: Framed, sheathed, windows fitted, some exterior facade materials attached

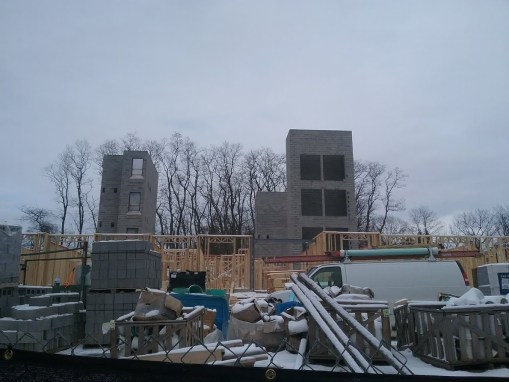

Apartment Building D: Foundation finished, stairwells erected, framing just starting

Apartment Building E: Foundation slab work

Apartment Building F: Foundation slab work

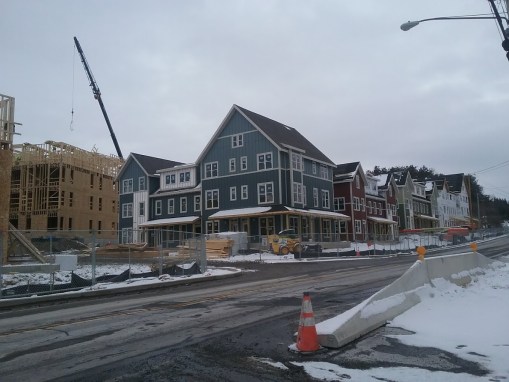

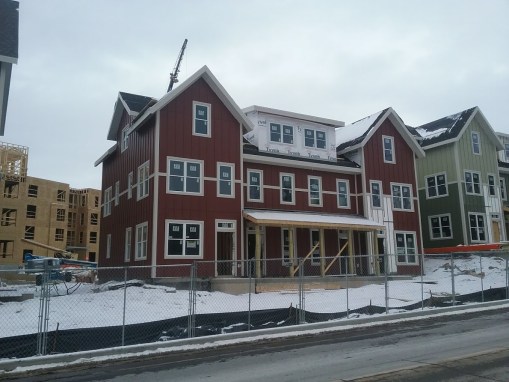

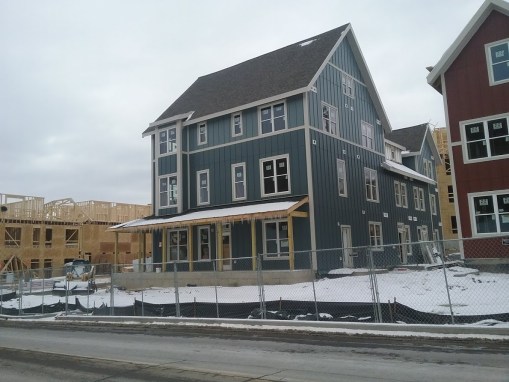

Townhouse Strings:

At, Bt, Ct, Dt, Ht1, Jt1, Jt2, Kt1, Community Center – unclear, not above ground level or readily visible

Et1 – slab

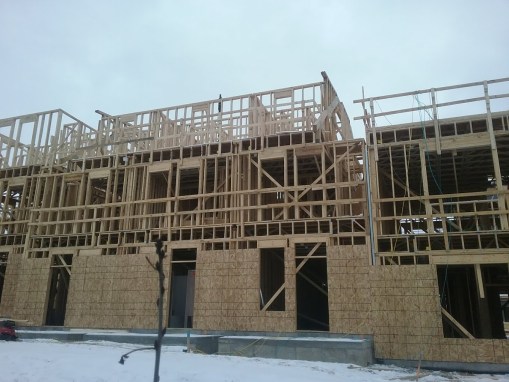

Ft, Gt2, Kt2 – framed, sheathed (partially for Gt-2), exterior facade work for Ft and Kt2

Gt1 – slab (in photos, now framing first floor based on webcam)

Ht2 – first floor framing

It1 – framed, sheathed, windows being fitted

It2 – framing

Lt, Mt – framing (top floor)

Nt, Ot, Pt – framed, windows fitted, fiber cement siding attached

I have to say, based off the work so far, I’m liking what I’m seeing, even with the tweaks the architectural designs and materials appear to be good quality. Here’s hoping the project team can maintain their tight schedule against the environmental odds.

Bank Tower Renovation Update, 12/2017

28 12 2017

Not everything can or should be new construction. Today, it’s a look at the Bank Tower renovation on the Ithaca Commons.

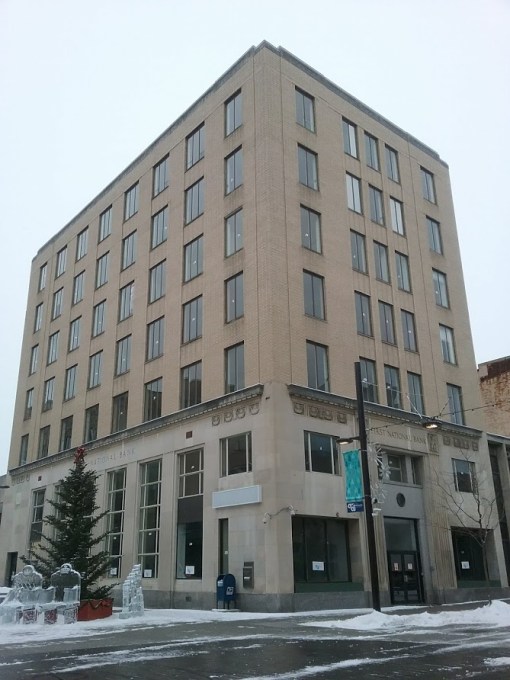

Bank Tower, a seven-story building located at 202 The Commons, dates from 1932, with two two-story additions from the mid-1960s. It suffered from a common issue with older office buildings – as they age, they become less suitable for the needs of today’s businesses. Reasons cited include smaller and less flexible floor plates, fewer amenities, less sustainable and ecologically-conscious structures, accessibility, and utility concerns (telecommunications/integrated wireless networks). A look at your typical office photo gives some insight to the changes –  rows of desks and file cabinets gave way to cubicles and desktops, and in many places those too are being replaced with portables and open office formats. That means that the owner either invests in significant updates to keep a building competitive to its newer peers, or letting it slip downmarket – from Class A (premium/prestige), to Class B (mid-market) and Class C (below-market) space.

However, the first question any owner asks when deciding whether or not to renovate is, will it be worth the investment? In the case of Bank Tower, that answer wasn’t clear. Over the past several years, Bank Tower had lost a number of tenants – law firm Miller Mayer moved into renovated space in the Rothschild Building, which left two floors vacant, and Bank of America sold its local presence to Chemung Canal Trust Company in 2013, which moved out of the building under acrimonious circumstances in the spring of 2016. The average office building is about 90% occupied, and Bank Tower was clocking in with far less than that.

It’s also important to look at the larger trends in the local market. In Ithaca’s case, office space is typically small-scale, and very little is built without a tenant already in mind. Ithaca’s economy is growing steadily, but since meds and eds just build their own space, and tech jobs tend to be “asset light”, the demand for rental office space isn’t growing much. Also, with Tompkins Trust Company building a new headquarters a couple blocks away, which would consolidate several rented spaces into their spacious new digs, it looked likely that there would be a glut of office space by the end of the decade.

The Fane Organization had purchased Bank Tower in 1997, and was well aware of the market’s challenges. They were also aware of the hot apartment rental market. The first plan, announced in July 2016, called for a $4 million conversion of Bank Tower into 32 units of housing with 51 bedrooms (mostly 1-bedroom and 2-bedroom units). Renovations typically don’t require planning board review, but any exterior changes, or changes visible to the inside from the outside, would require Ithaca Landmarks Preservation Council (ILPC) approval, since the building sits in the Downtown Historic District. John Snyder Architects has been retained to design the new interior floorplans. In accordance with the city’s zoning, the first floor has to remain an “active use”, generally retail or commercial services, but some traffic-generating public and community options are permitted.

Around Spring 2017, rumors began to circulate that the residential conversion plan had been cancelled, and that the Fane Organization was in negotiations with a potential tenants. Those rumors panned out when CFCU Community Credit Union announced plans to move into a renovated Bank Tower next year, renting the building for use as their new headquarters. The credit union, established in the 1950s, has ten locations and about 184 staff, and has been in an expansion mode over the past several years. The move is expected to relocate 30 employees to downtown Ithaca from the current HQ in suburban Lansing, and create 20 new jobs as the credit union continues to expand.

According to a press release, the fourth and fifth floors will retain a traditional layout, while floors three, six and seven will move to an open-office format. CFCU will host a service branch on the ground floor. New windows, communications systems, and high-efficient utilities will be installed in the building. The sixth and seventh floors appear to be spec space, with tenants TBD.

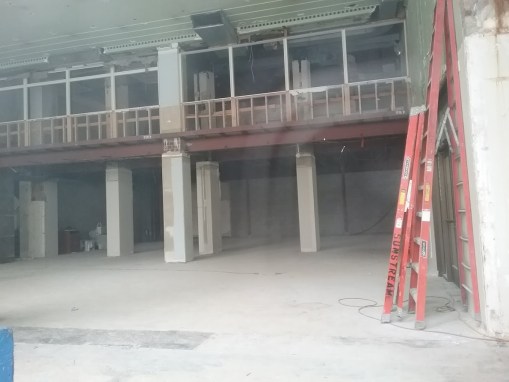

On the ground and second floors, it appears the lobby area is being opened up to give it a more spacious feel, and interior demolition work continues, given the rubble chute off the side of 111 North Tioga Street.

107 South Albany Street Construction Update, 12/2017

22 12 2017

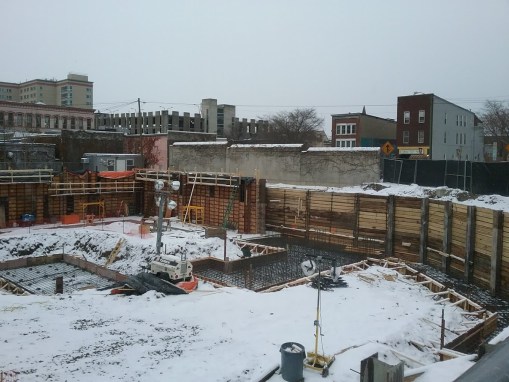

Since October, it looks like the foundation slab has been poured over the footers, and the construction crew is preparing to start work on framing. Judging from the materials on-site, it looks like wood-frame with Huber ZIP panels. Wood-frame structures tend to rise quickly, so once the project team is ready, it should go up at a rapid pace, and probably top out in within just a few weeks. The 11-unit, $1.1 million apartment building is expected to be ready for occupancy by July.

It’ll be interesting to find out what Stavros Stavropoulos’s next project is, since the plan for a pair of duplexes at 209 Hudson Street was kiboshed by the city after the South Hill zoning overlay went into effect. If he’s looking at other locations along the State Street Corridor, he’d likely find the planning department and Common Council more amenable. If his name shows up in any sales, I’ll note it in the round-up.

On that note, expect a brief holiday pause in the daily posts. They’ll be back next week.

For reference, project summary here.

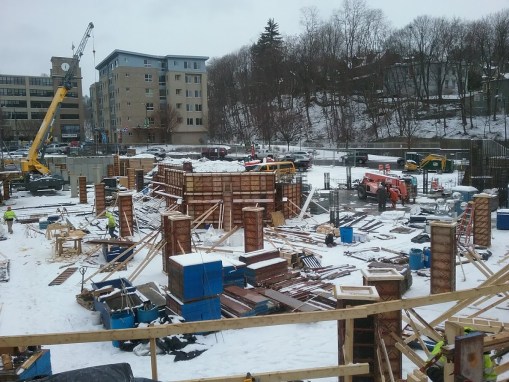

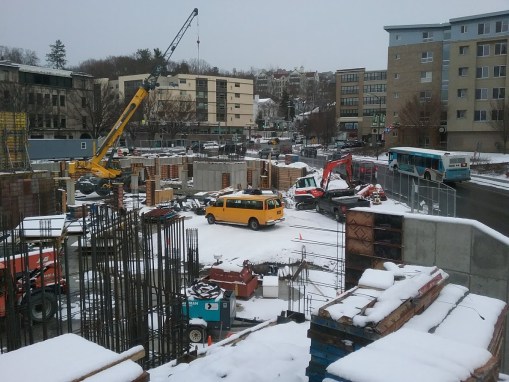

City Centre Construction Update, 12/2017

21 12 2017

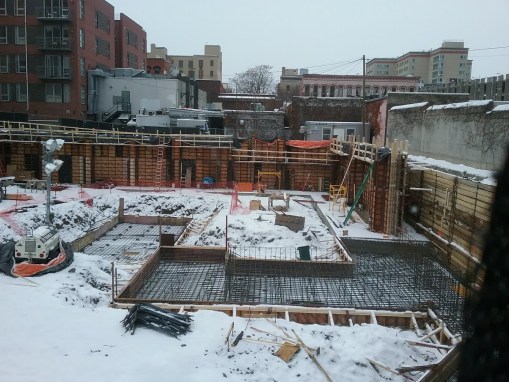

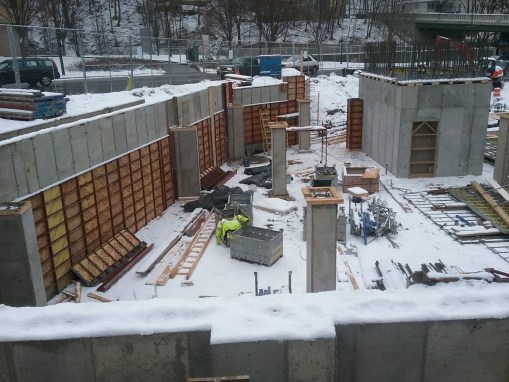

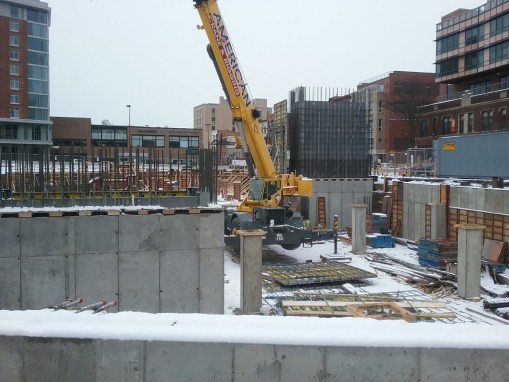

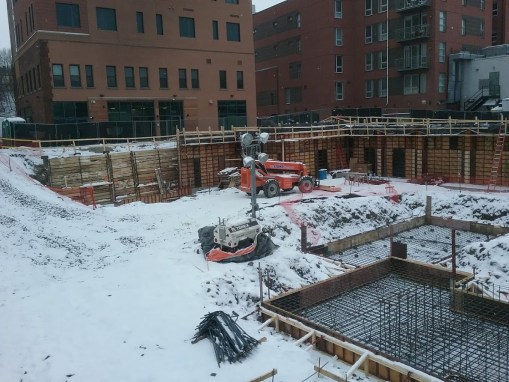

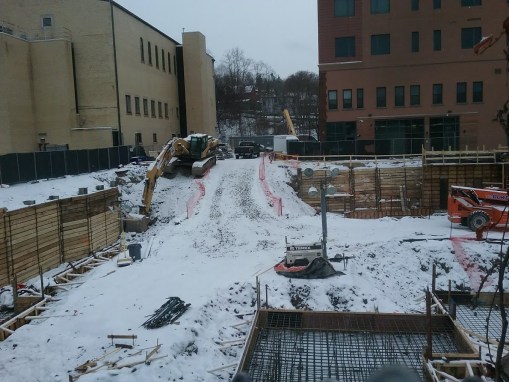

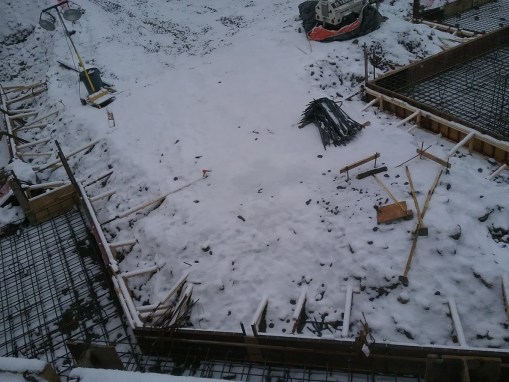

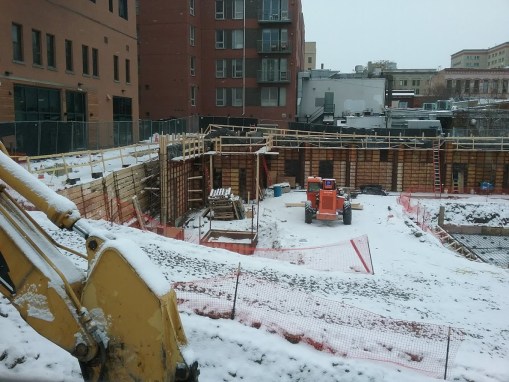

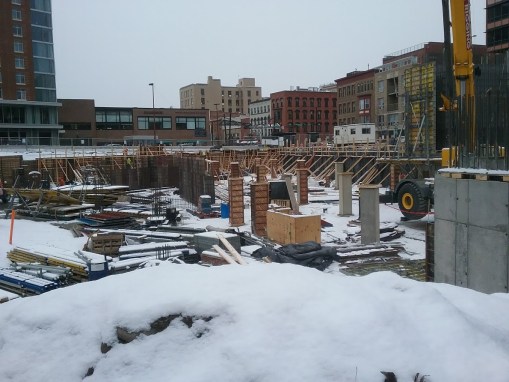

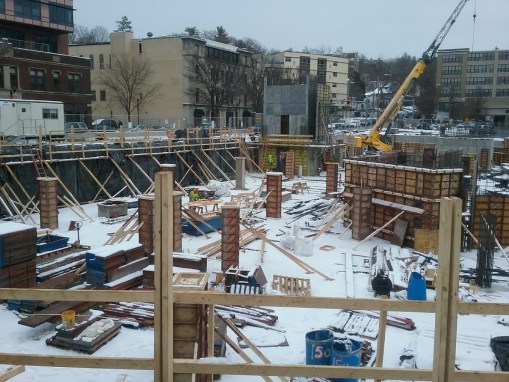

As with the Hilton Canopy Hotel under construction just across the street, City Centre is in the middle of foundation work. Steel forms with plywood facing have been erected and braced along the perimeter of the building footprint. In fact, it looks like the project team is using the same Symons Steel-Ply system being deployed at the Canopy site. The piles have been driven and the foundation slab is poured. The team is slowly making their way to the steel frame of each pile, encasing it within forms before pouring the concrete, letting it cure, and then removing the forms to reveal a concrete/steel column ready for vertical additions. The elevator cores and stairwell columns are also on the rise. – the elevator core facing East State Street appears to be the furthest along.

We finally have a named general contractor, and like the architect for the City Centre team (Humphreys & Partners of Dallas), its a new entrant to the Ithaca area – Purcell Construction Corporation, with offices in Richmond, Virginia and Watertown, New York (an hour’s drive north of Syracuse). It appears that they have plenty of experience with multi-story towers and large structures, which is no doubt an asset for the project team.

As I previously said, as structural steel takes height here and with the Canopy and Harold’s Square, downtown Ithaca is going to look like one big advertisement for TCAD.

Hilton Canopy Hotel Construction Update, 12/2017

20 12 2017

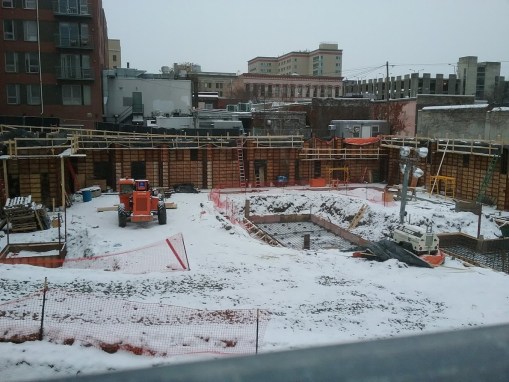

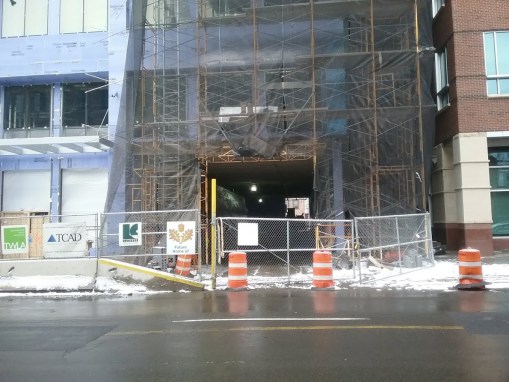

Given how long this project seemed to be be stuck in post-approval financial purgatory, it still surprised me when I see construction underway at the Hilton Canopy hotel site on the 300 Block of East State Street.

One imagines that summer 2018 will be a construction nerd’s paradise, as cranes for City Centre, Harold’s Square and the Hilton will dot the city’s skyline, no doubt making their way into future TCAD imagery. But for now, it’s subsurface work. The Canopy is excavated, lagging, H-beams and steel tiebacks have been erected to hold the soil back, and wooden forms are being assembled for the concrete pours. Forms are typically plywood, sometimes aluminum or steel, and are braced to resist the pressure from the concrete as it is poured to make the foundation walls. For commercial buildings like the Canopy, stronger steel forms with plywood sheet ply are used. In this case, since the walls are quite tall, workers have installed brackets and scaffolds along the forms so that they can stand and work higher up on the walls. Specifically, I think it’s a Symons Steel-Ply Forming System that is being used.

The footprint of the site also has some less imposing wood forms that have been assembled, and interior to those some steel rebar has been laid, to add strength to the concrete as it cures. Some of the basement concrete slab has already been poured along the perimeter, and some is being readied for pours. The elevator shaft and north stairwell will occupy some of the footprint of where the rebar grid is in the second and third photos below. The basement will consist of storage rooms, utility space, a fuel room, laundry facilities, housekeeping office, main offices for hotel staff and back-end operations, restrooms and a breakroom. The smaller forms with the square outline on the south side of the site look to be about where the money counting room and/or data/communications room will be.

Note the light rigging onsite – December’s short daylight hours are no conducive for outdoor construction. Floodlamps are a way around that.

Tompkins Financial Corporation HQ Construction Update, 12/2017

19 12 2017

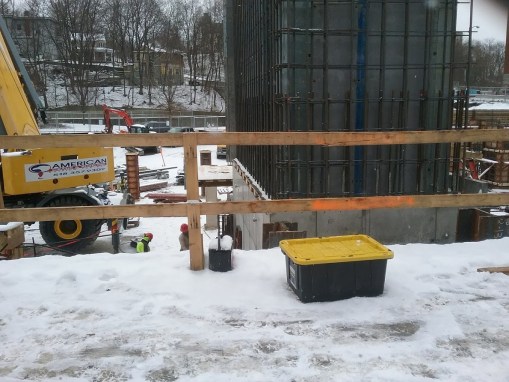

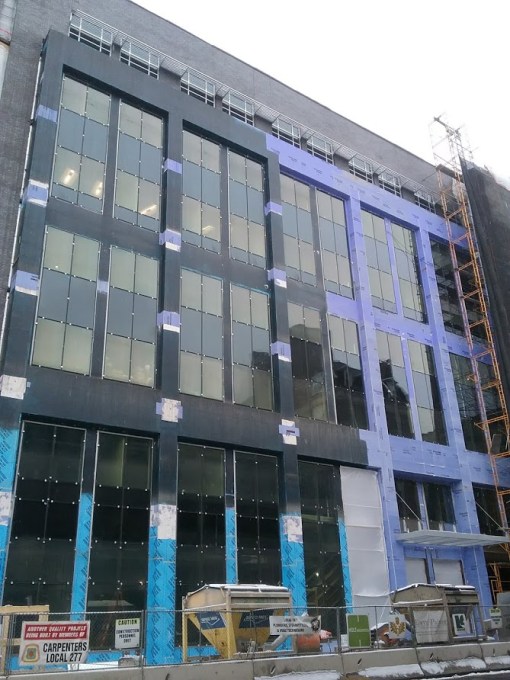

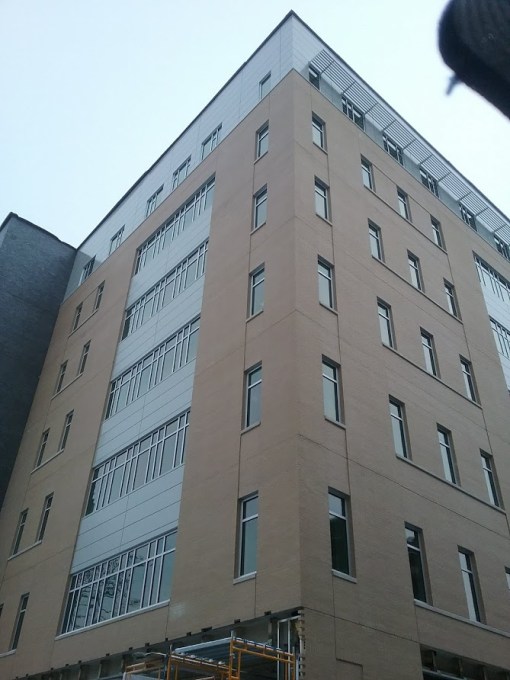

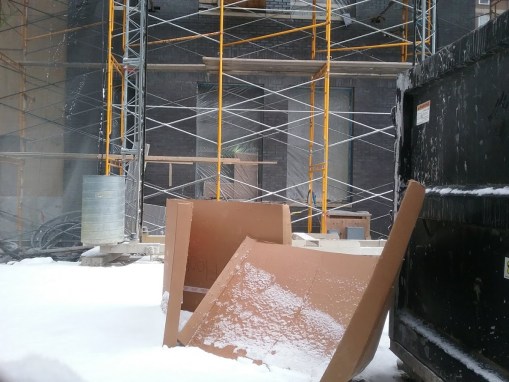

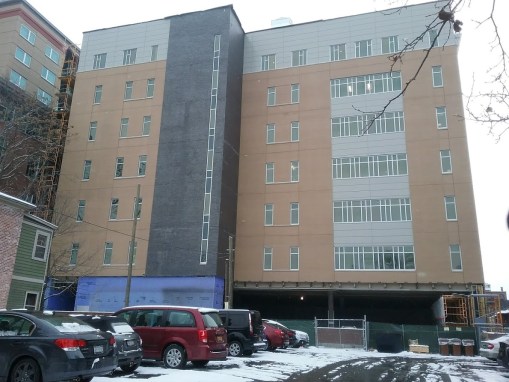

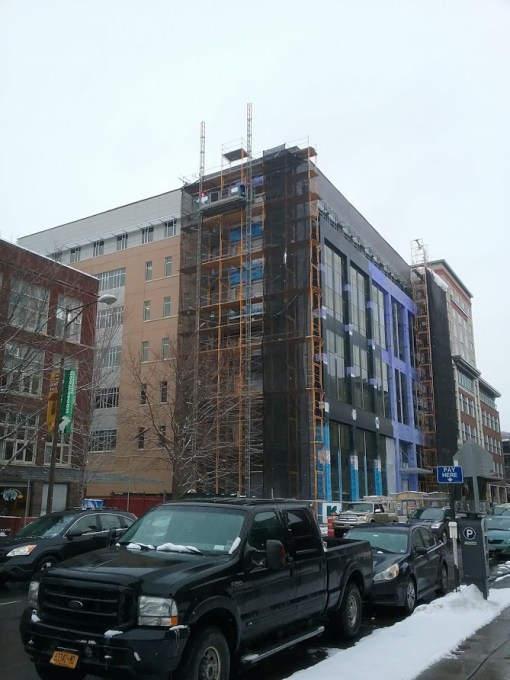

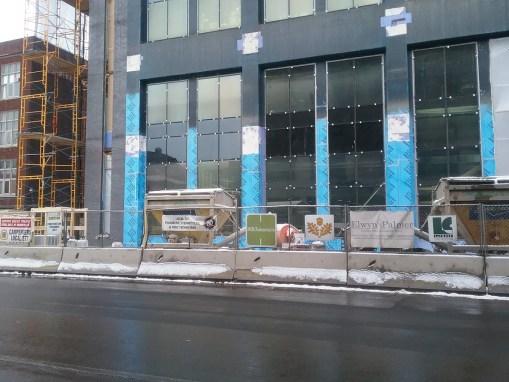

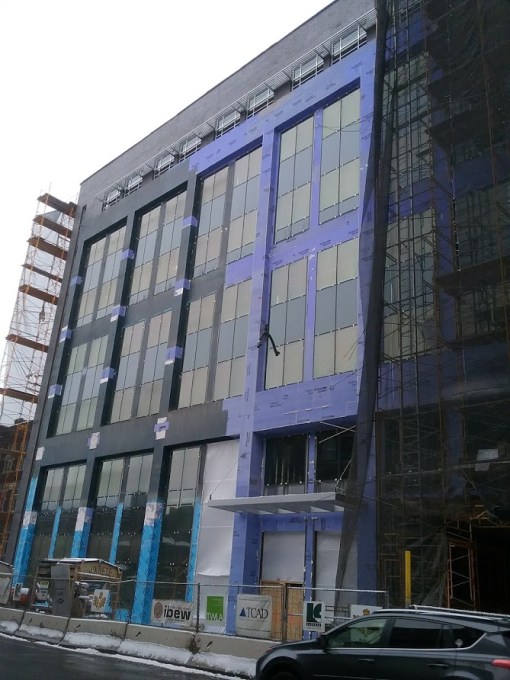

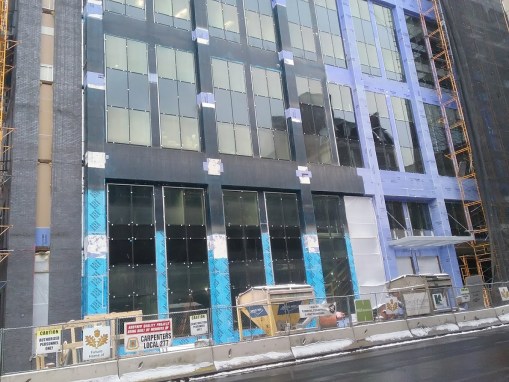

Most of the scaffolding and netting has been taken down on the Tompkins Financial Headquarters in downtown Ithaca. Most of the glazing has been completed, and the Endicott “manganese ironspot” brick veneer is being attached, which isn’t so much a jet black as it is a dark grey. Definitely not as dark as the waterproof coat going on over the gypsum sheathing on the front facade, which will be finished with a grey stone veneer. Not sure why the change of materials on the front facade between U.S. Gypsum panels and Carisle CCW-705 air/vapor barrier, since it doesn’t look like barrier is being applied over the whole of the front before the coating is applied. If someone from HOLT Architects or LeChase Construction knows, feel free to chime in.

It appears there was one design change made late in the process – the rear stairwell, which was initially face with light grey aluminum panels, has instead been faced with the dark Endicott brick. Adds more variety perhaps, but I think the panels made for a less imposing rear face. We’ll be seeing the exact same color and brand of brick on another project, The Lux in Collegetown, where it will face the lower floors of the Dryden Road facade.

There’s still plenty of work left with the exterior finish work, stone veneer and granite base, not to mention interior work like drywall, fixtures and finishes. TFC staff should be moving into the new digs by the end of May.

The Lux (232-236 Dryden Road) Construction Update, 12/2017

18 12 2017

Some progress on Visum’s latest project, “The Lux” at 232-236 Dryden Road in Collegetown. 232 Dryden, the building closer to Dryden Road, has started work on exterior framing – the partially-above grade basement level, built into the slope of the site, appears to have been framed with Amvic insulated concrete forms (ICFs), similar to those seen at the Ithaka Terraces and the Fox Blocks at the Thurston Avenue Apartments. These are thermally insulated plastic blocks filled with concrete – they tend to be a more expensive approach, but they also tend to have a higher grade of insulation (higher R-value), making for a more energy-efficient structure. There has been talking of making the complex net-zero energy capable, provided that the energy of an off-site solar array can be procured. STREAM, the architect of The Lux, also did the Ithaka Terraces. The exterior walls will be assembled block by block, with new pours as rows of blocks are set in place. The rebar provides additional stability. It appears the cinder block elevator core/stairwell has been assembled as well.

232 Dryden might be the more visually prominent of the two building, but it is also the smaller one – it will have 20 units and 53 bedrooms. 236 Dryden will host 40 units and 138 bedrooms.

Speaking of 236 Dryden,  Welliver has the foundation excavated, and the steel piles are in. However, judging from the steel rebar sitting on the edge of the site, the concrete pours have yet to take place, and it looks like the wooden forms are just now being built on the far side of the footprint.

Pessimistically, I could note that this is one of the few Collegetown projects that was able to move forward after the building code change that brought multiple other projects to a halt – the power lines on Dryden Road aren’t close enough for the project to infringe on the new regulations. I had heard Visum might actually pay for the burial of power lines on the 200 Block of Linden Avenue, but even if they did, they would still have to deal with NYSEG’s slow schedule.

400-404 & 406 Stewart Avenue Construction Update, 12/2017

17 12 2017

400-404 Stewart Avenue, a.k.a. the former Chapter House site, is fully framed and the brickwork is in progress. The brick veneer is Redland Brick Inc.’s Heritage SWB, and is similar in appearance to the original brick of the Chapter House, which was damaged beyond repair in an April 2015 fire. So the way this has gone is that yellow closed-cell spray foam was applied over the sheathing, probably by a subcontractor such as Goodale Spray Foam out of King Ferry. Closed-cell spray foam, made with polyurethane and applied a few inches thick, provides insulation under the brick. Brick is a tricky material in some ways – the plywood ZIP Panels are great for sealing a structure to make it air-tight, but brick absorbs moisture, so the spray foam not only serves as an insulator, it also provides a protective moisture barrier between the plywood and the brick. It’s typical to have a drainage gap underneath the brick so that they can dry out, otherwise the uninsulated brick is at risk of long-term moisture damage.

The roof looks to be covered in tar paper or similar material; this will eventually be layered over with chamfered asphalt shingles. The roof ZIP panels that make up the “awning” being built over the first floor will be covered in shingles as well, but those will be more expensive simulated slate. The trim pieces like the cornice may be cast stone or fiberglass over wood, and it looks like the window sills and heads might be cast stone. It looks like they’re using Marvin Windows for the windows themselves.

406 Stewart Avenue is still being framed with ZIP panels, now up to the third floor with just the roof trusses left. The drawings I have on file suggest the fenestration has been changed – the position and size of the second floor windows are different from the renderings, in particular the window on the far left of the front face, and one of the windows on the north side was moved further back from the street. It suggests some modest interior alterations, but the ILPC will be watching this like a hawk since these builds are under their jurisdiction (the East Hill Historic District).

News Tidbits 12/9/17: Not Enough Time in the World

9 12 2017

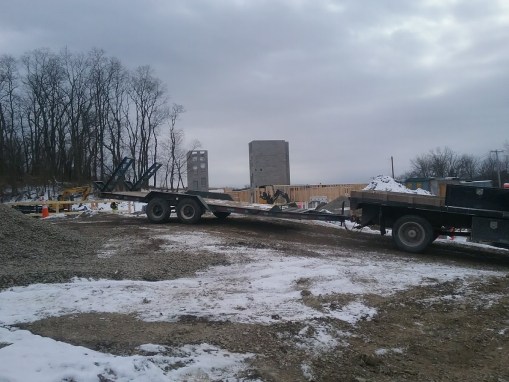

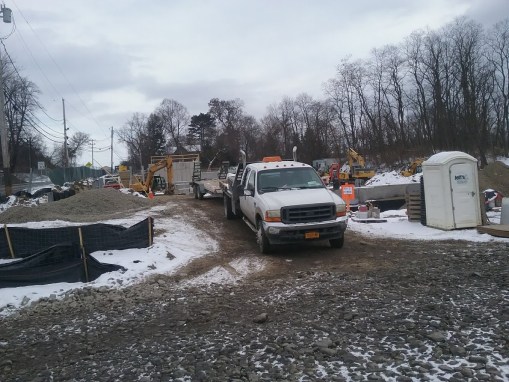

1. The good news is, Maplewood is progressing. The bad news is, it is not progressing fast enough. A combination of bad weather (rain-outs), and staffing issues. The weather delays had been so bad (with rain 2.5x monthly normals in October) that some subcontractors walked away to take other jobs – while the ~200 Maplewood construction jobs are quality union labor, it’s been difficult to get a full week’s work in. It’s a Monday-Friday job; with a rain-out, they lose a day in the week. That means they also lose out on a day’s pay. Over the past year, 37 days have been partially or fully rained out. A provision in the subcontractors’ contracts allows them to leave for other jobs id the issue becomes too severe, so some have done just that. Not hard feelings, just a tough situation for everyone.

Now about 25 days behind a very tight schedule, EdR and LeChase are asking to be allowed to regularly work 8 AM – 4 PM Saturdays. The town is open to this, but wants more documentation before signing off. So, expect a six-day workweek during the winter and spring. The goal is still to deliver the $80 million, 872-bed project by July.

2. The Seneca Street Garage is “showing its age”. As the garage is now about 45 years old and is designed to last about 50 years, some components are starting to deteriorate. The city has constructed some shoring posts to keep the concrete pillars relatively stable. They are not at risk of collapse, but the tension cables, which are used in combination with rebar to provide for a heavy-duty concrete structure with fewer columns, are starting to wear out. Decades of salt, water and corrosion will do that.

The city will lose about 20 parking spaces from the life-extension measures. The Times is reporting that the city hopes to get another ten to fifteen years out of the garage, and hope to have a plan for replacement parking in place within ten years. That could be a demo and rebuild of the garage, or it could be something more substantial, like the Green Street Garage project. It’s something to mull over now, but there are no big decisions planned anytime soon. Perhaps a Seneca Street rebuild with mixed uses ends up being one of the big urban developments of the late 2020s.

3. A development site on West Hill has exchanged hands. As covered previously, Bella Vista was a planned 44-unit condominium project on Cliff Street that was approved in 2007, and never came to fruition. The site it was proposed for, an 11.71 acre property at 901-999 Cliff Street, was put up for sale in December 2015 for $395,000. Finally, it has been sold.

The developer, Mauro Marinelli as Primary Developers Inc., sold the land to American Blue Sky Holdings LLC for $330,000 on the 5th. The LLC is owned by local businessman Greg Mezey, who previously bought the 12,000 SF medical office building next door at 821 Cliff Street for $945,000 in February 2015. Since then, he and realtor Ryan Mitchell have undertaken some modest building and site improvements. As Red Door Rentals, they own and manage a few apartment houses with a total of about 25 bedrooms.

So what does that portend here? Good question. Watch and wait, for now. The Bella Vista project could still be built, but it must be re-approved by the city of Ithaca, since project approval is only good for two years. Zoning is R-3a, primarily residential uses with up to 4 floors and 35% lot coverage. Parkin is one space per unit or three bedrooms (whichever produces more), and small-scale commercial is allowed with a special permit. The site’s topography is a challenge, but the size of it and its proximity to downtown and the West End make it an interesting opportunity.

4. It looks like the first phase of Dryden’s Maple Ridge subdivision has just about filled out. For owner/developer Paul Simonet, it’s been a long time coming – the development launched right before the recession in 2008, and development didn’t really take off until the economy recovered. In 2013, there were three houses. By November 2014, only four houses had been built, with a duplex underway. Now, there are ten homes, and just about all one of the home lots have been sold. Some of the lots in phase one were combined by buyers.

Interesting, many of the homes built in Maple Ridge are modulars – I half-jokingly suggest that Carina Construction take prospective buyers through here to show them the variety of options one can pursue with modulars. It looks like this latest build on Applewood Lane will also be a modular – the foundation is built (note the dark Bituthene membrane for moisture protection), and the pieces will be trucked over and craned and assembled shortly, if they haven’t been already.

Ultimately, Maple Ridge is supposed to be three phases and 50 lots, and phase two will have about 29 lots, and since these are larger, they’re less likely to consolidated as phase one’s were. Given the need for a new road and infrastructure, sales seem unlikely until well into next year. The village minutes (the few they upload) does show that Simonet is actively pursuing the second phase.

It also answers a question from last week – the Elm Street office/warehouse complex will be the new home of the Ithaca Ice company, after some modest renovations.

5. The Lakeview affordable housing plan for the 700 Block of West Court Street, now called “West End Heights” was selected to receive a $100,000 grant from the inter-municipal and Cornell affordable housing fund (CHDF), but the funds will be delayed a little bit because they need to be moved into the 2018 budget, as the check will be going out in 2018.

6. The latest phase of the Village Solars (the reconstruction of 102 and 116 Village Circle) is being built with a $6 million construction loan from Tompkins Trust Company. The agreement was uploaded to the county’s records on the 7th. The contractor is “Actual Contractors LLC” with an address at Stephen Lucente’s home on the lake – it’s their in-house construction crew. Albanese Plumbing will be rigging sprinklers, heating and water pipes, T.U. Electric will be doing electrical and fan installations, and Bomak Contractors of Pennsylvania is the subcontractor for excavation, bedding and foundation work. Apparently Larry Fabbroni, the consulting architect, charges $90/hour for design work, while engineering/surveying is $107.50/hour.

102 and 116 comprise 42 units (24 and 18 units respectively), but if you’ve been reading the construction updates for the project, then you already knew that. The loan says both buildings have to be completed by August 15th, 2018.

7. Not a whole lot going on at the moment. Lansing town will be hosting a Planning Board to look at a telecommunications tower, and three new 1-acre home lots to be carved from a larger lot off East Shore Circle. The city’s project review meeting is so slim, they didn’t need to attach any files – just the old business with the Sophia House addition on the Knoll, and that’s it. The city Board of Public Works will be looking at plans for a new inclusive playground at Stewart Park.
